The main construction stages of «Gazprom centre» are presented as construction site panoramic images.





                    -

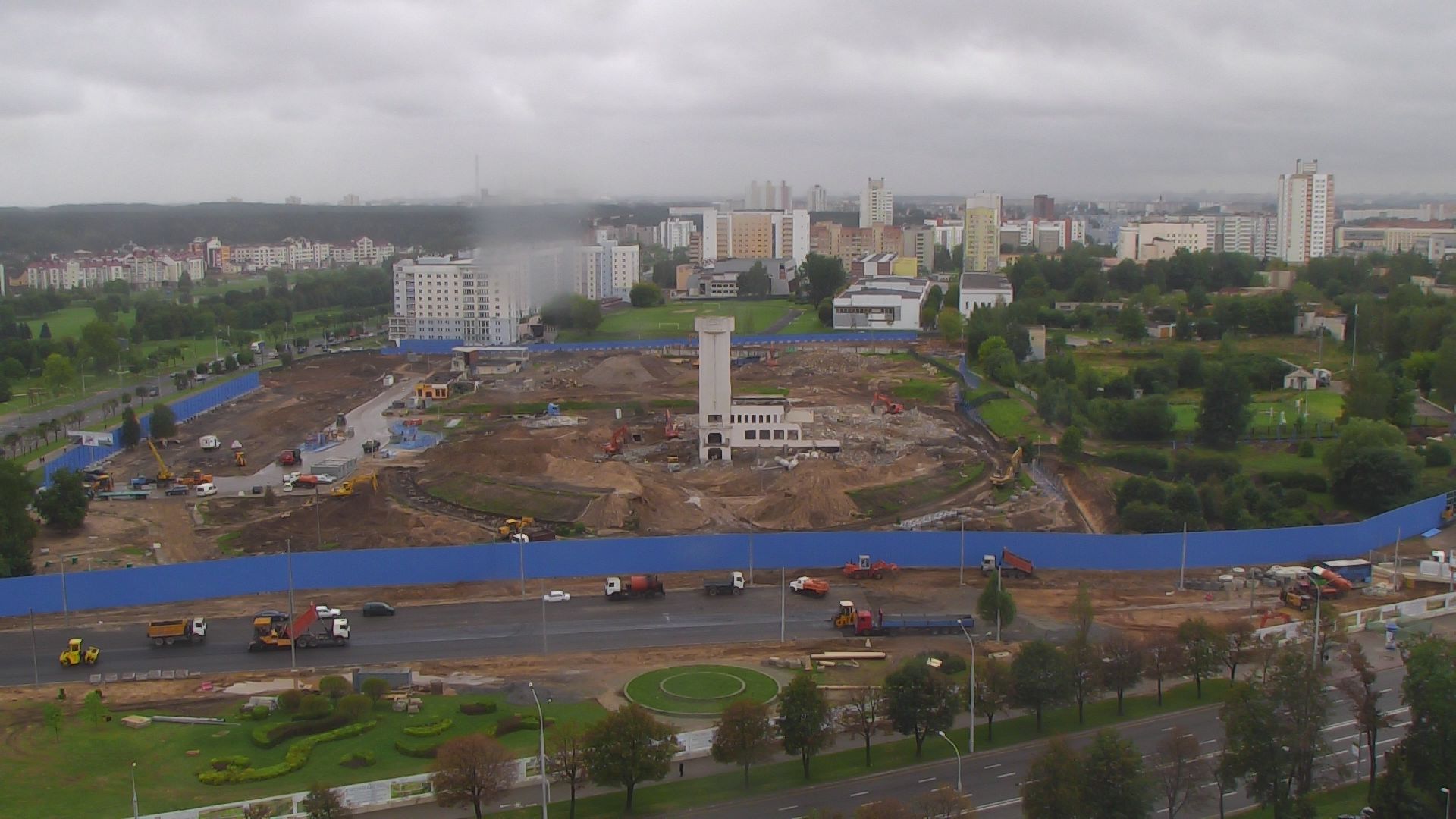

                                    28 August 2014 Preparation for construction Preparation of the 8.27 ha site for construction: deconstruction of the buildings, facilities and utilities. In line with the green construction technology, all waste and materials made available in process re-used in accordance with city needs.


-

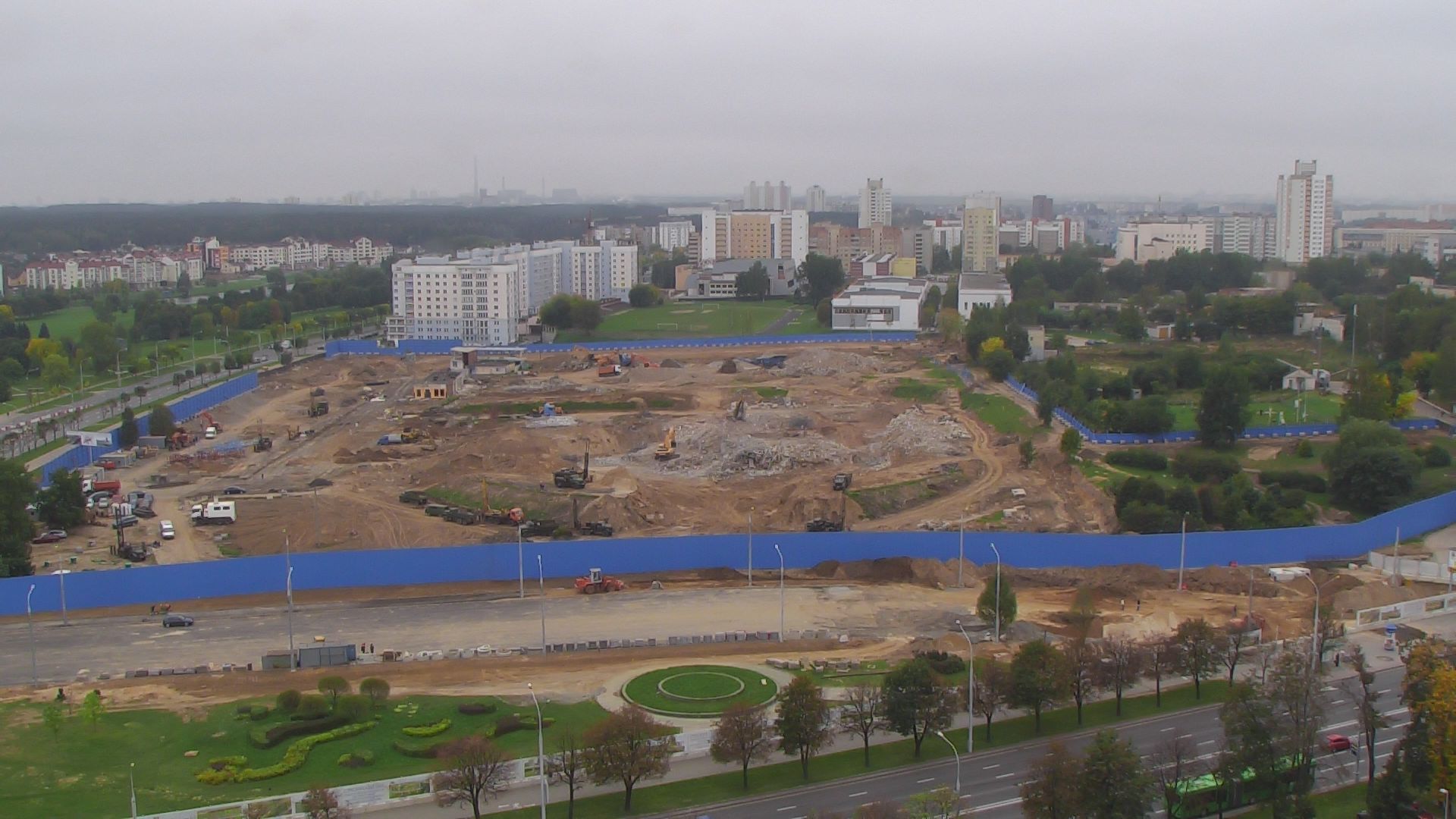

                                    15 September 2014 Preparation of site continues Total of 480 thou.m3 of soil excavated on site, exceeding excavation during construction of shopping mall «Stolica» in Minsk.


-

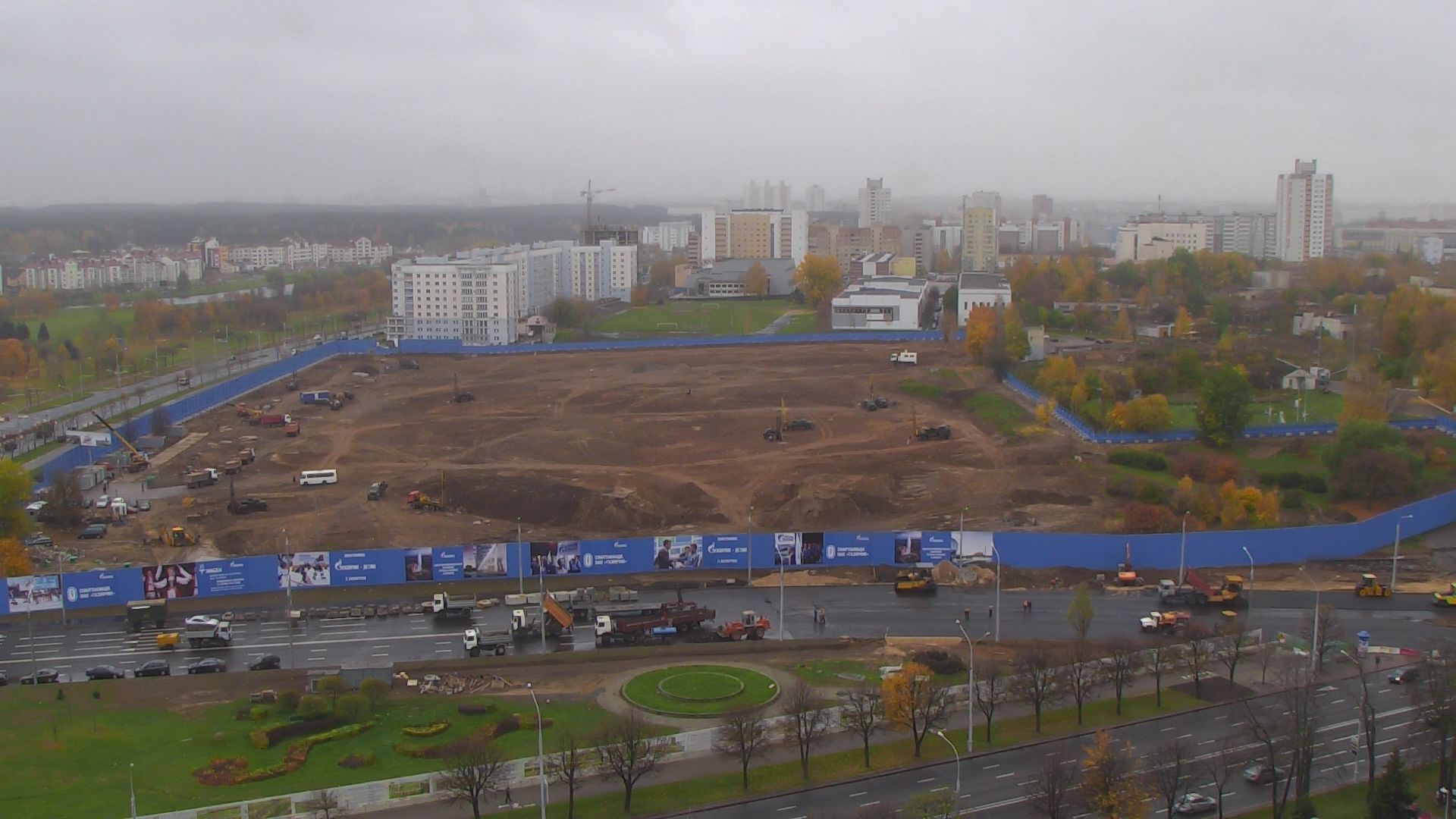

                                    15 October 2014 Geotechnical survey in progress Geotechnical survey launched.


-

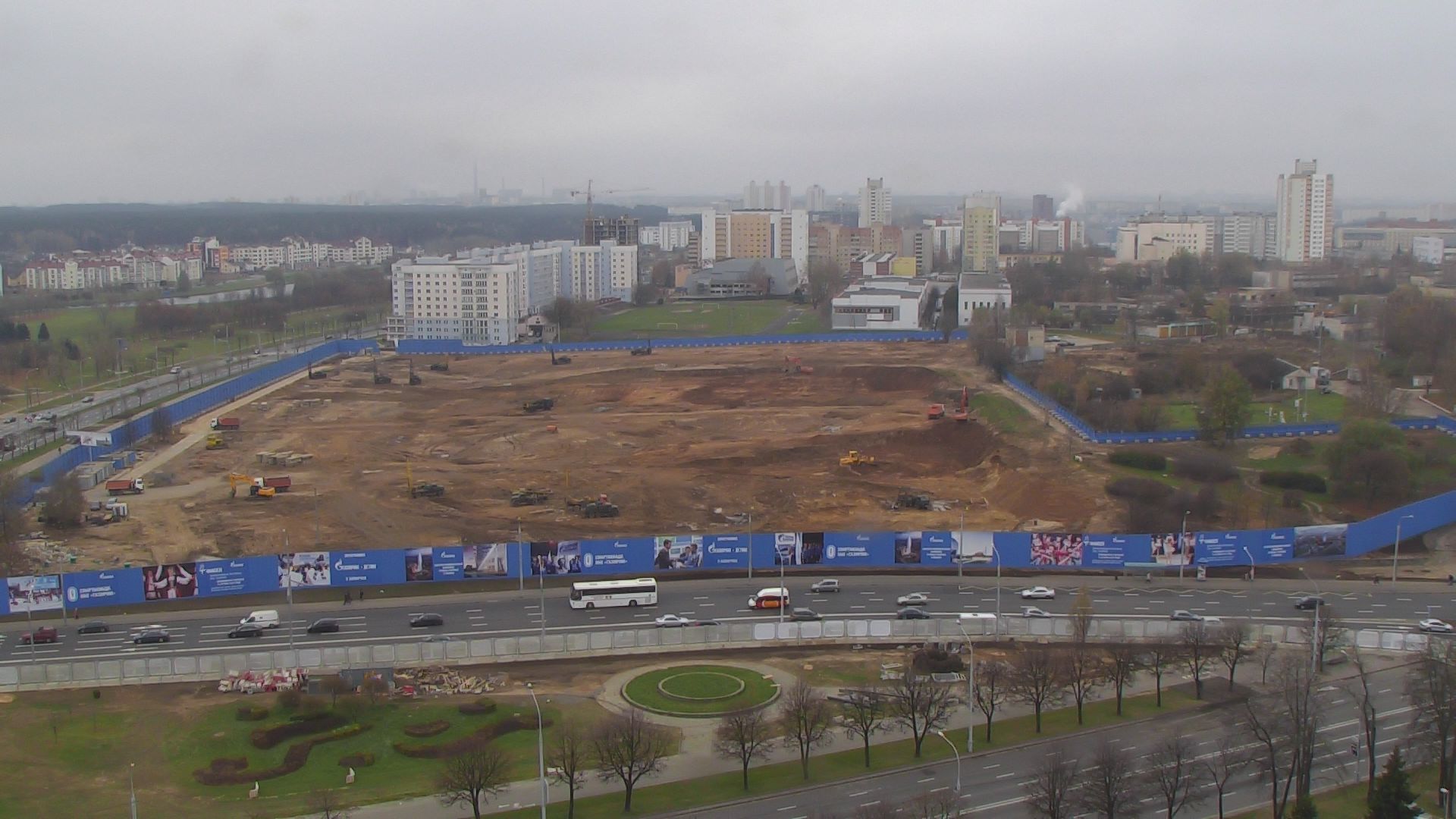

                                    2 November 2014 Disassembly complete Site ready for construction work.


-

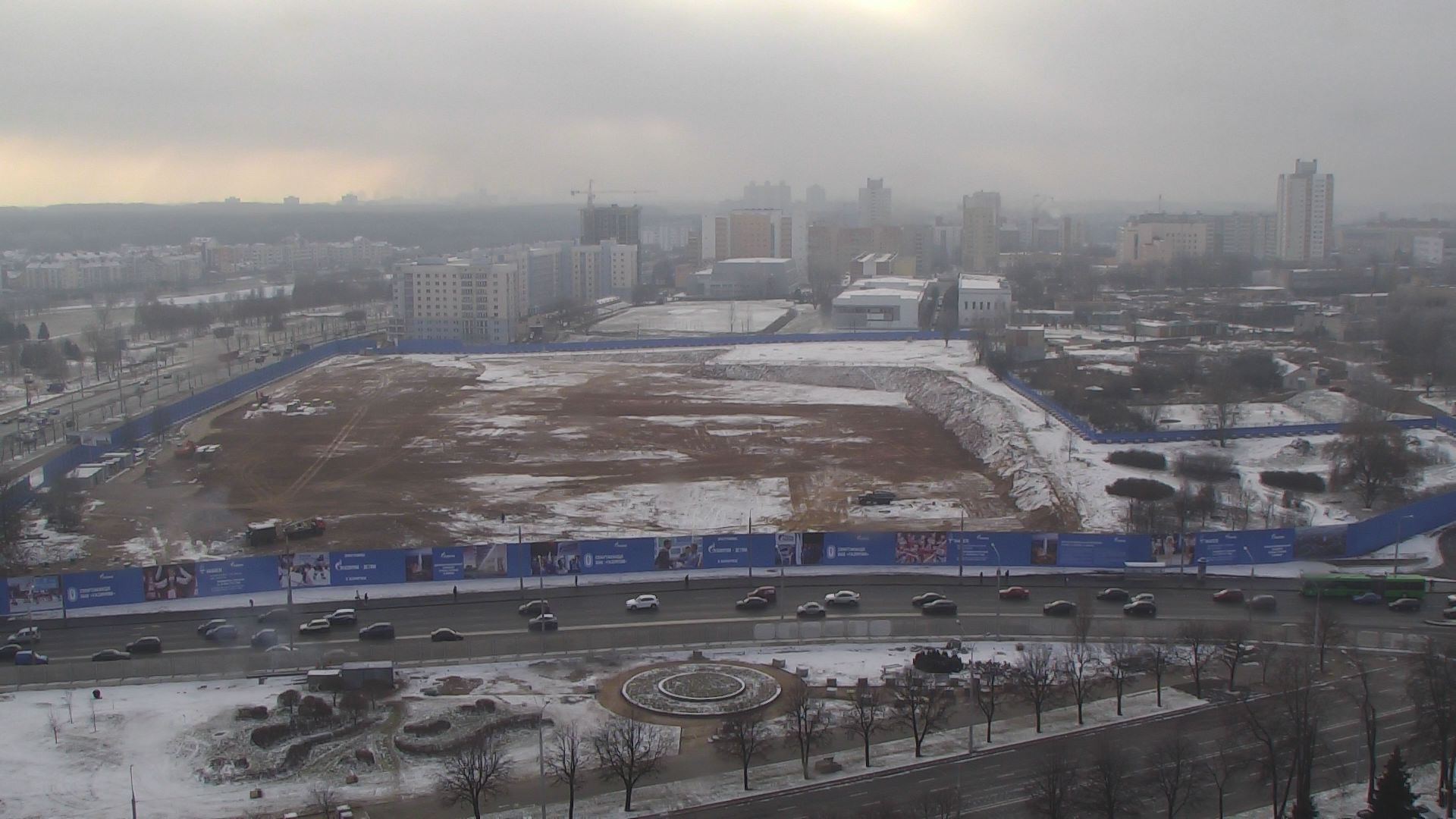

                                    1 December 2014 Start of design work Geotechnical survey complete, site levelled.


-

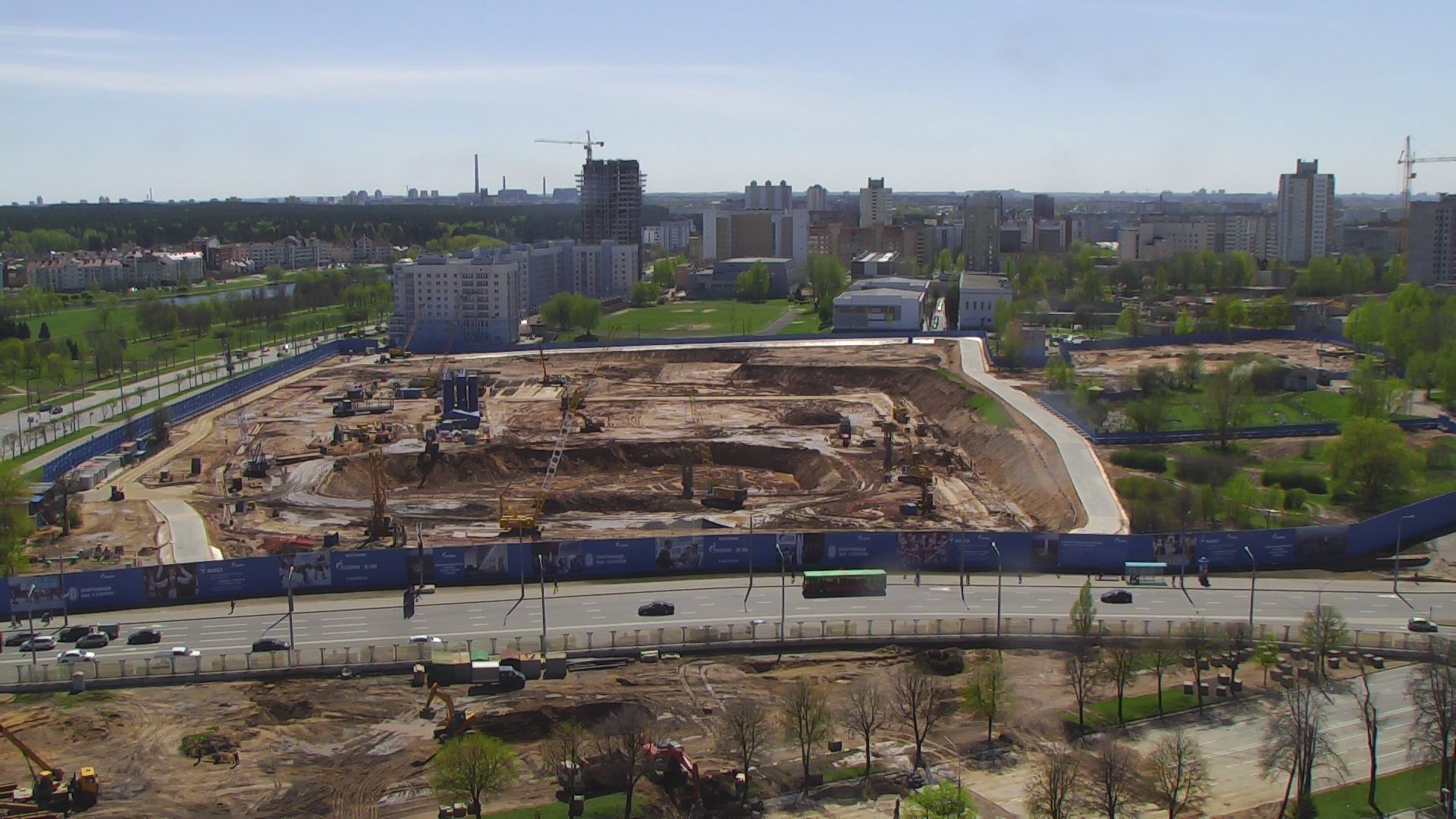

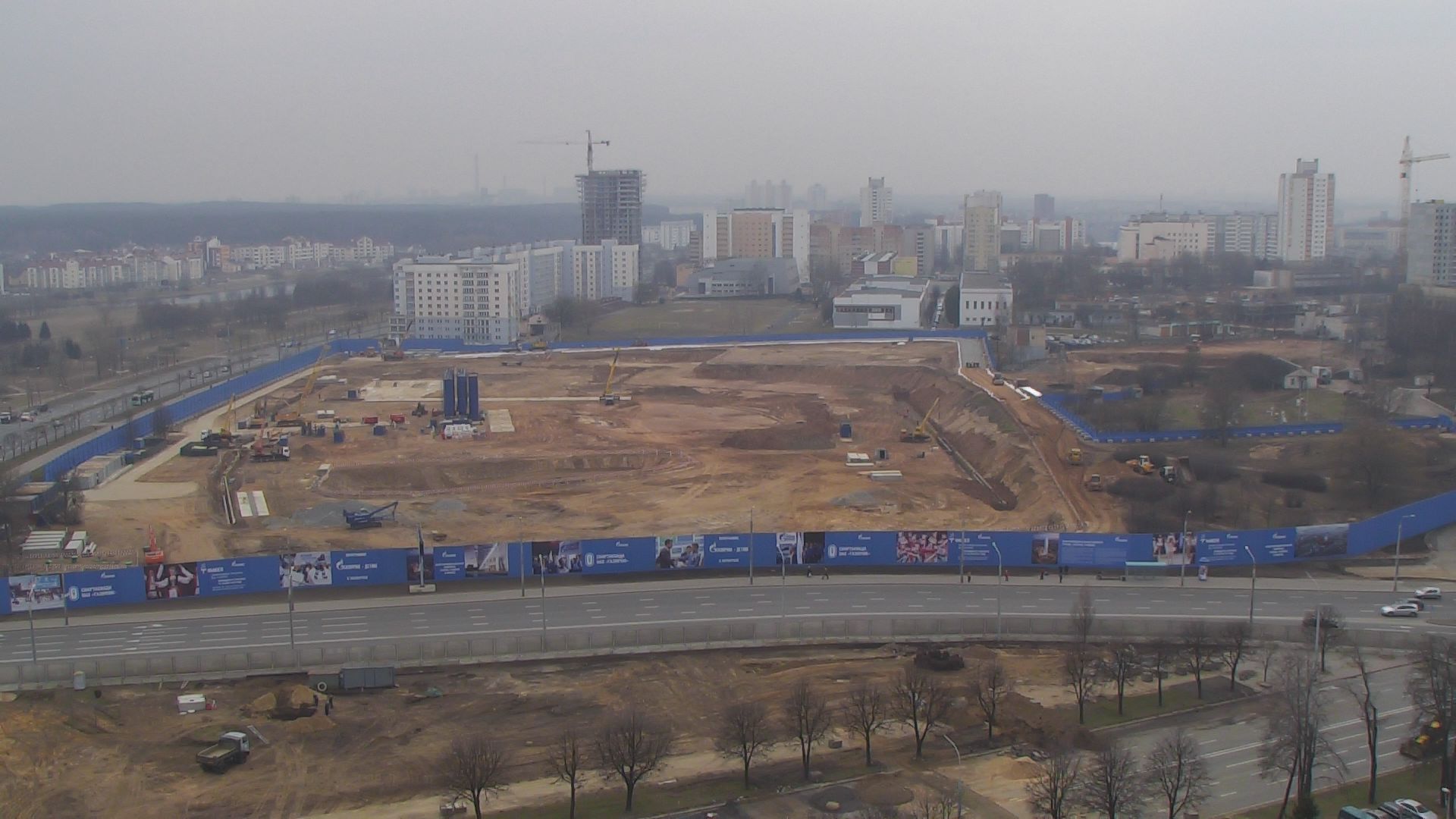

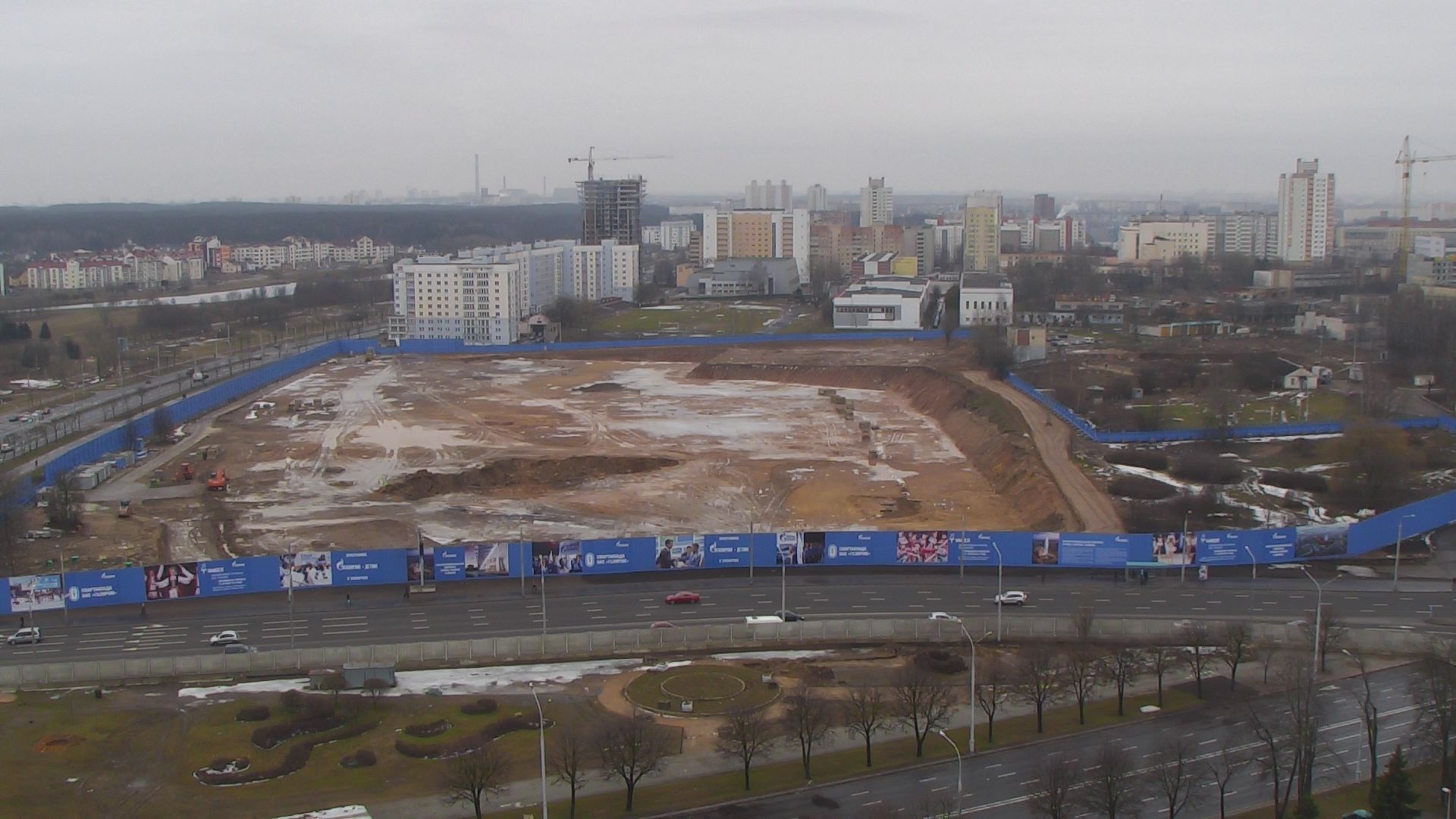

                                    1 March 2015 Design «Stage A» Temporary ring road construction. Start of pit excavation. Excavation depth - up to 20 m.


-

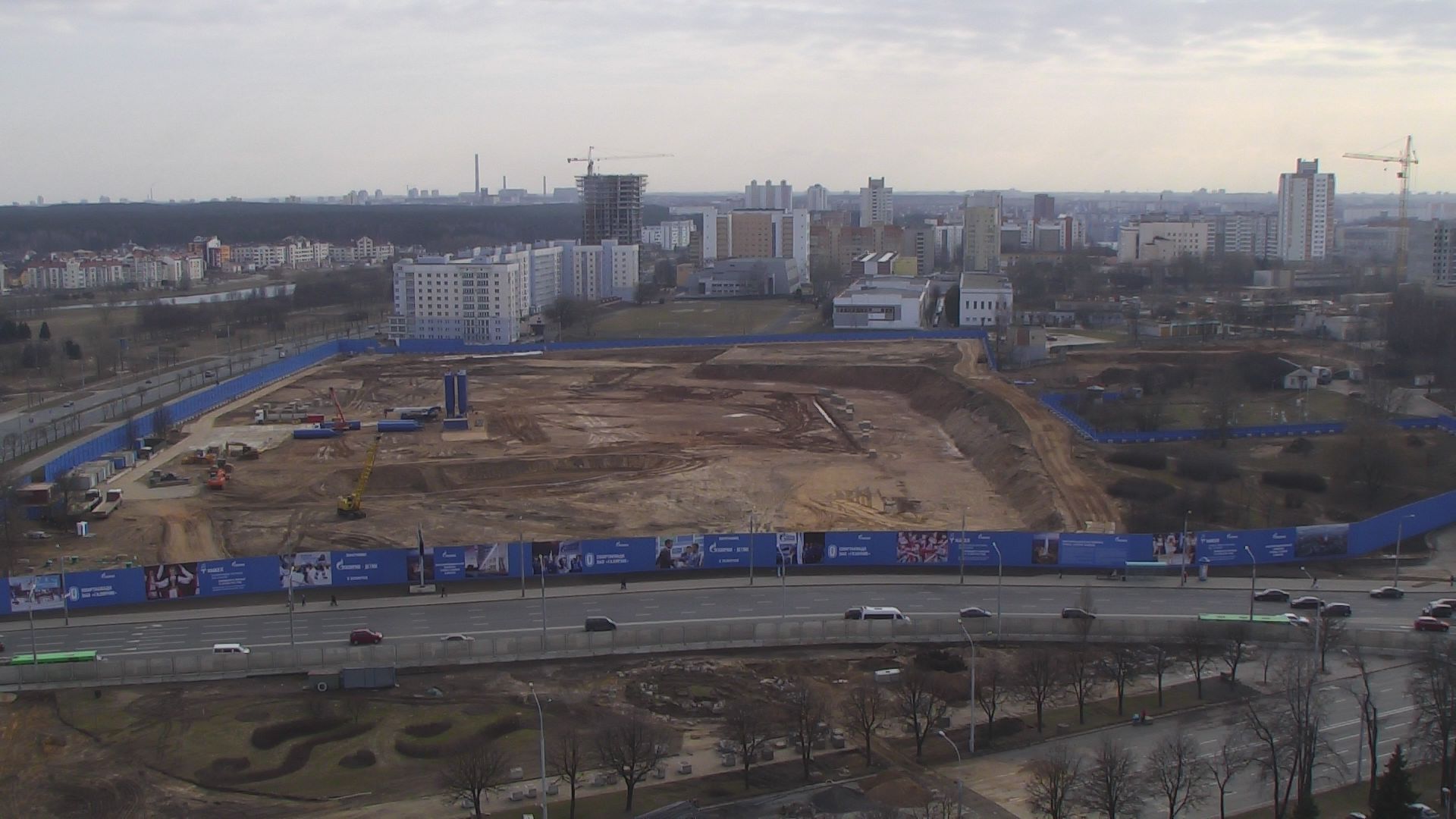

                                    15 March 2015 Bentonite plant installation Trenches filled with bentonite to prevent collapse of walls. Start of excavation shoring with diaphragm wall.


-

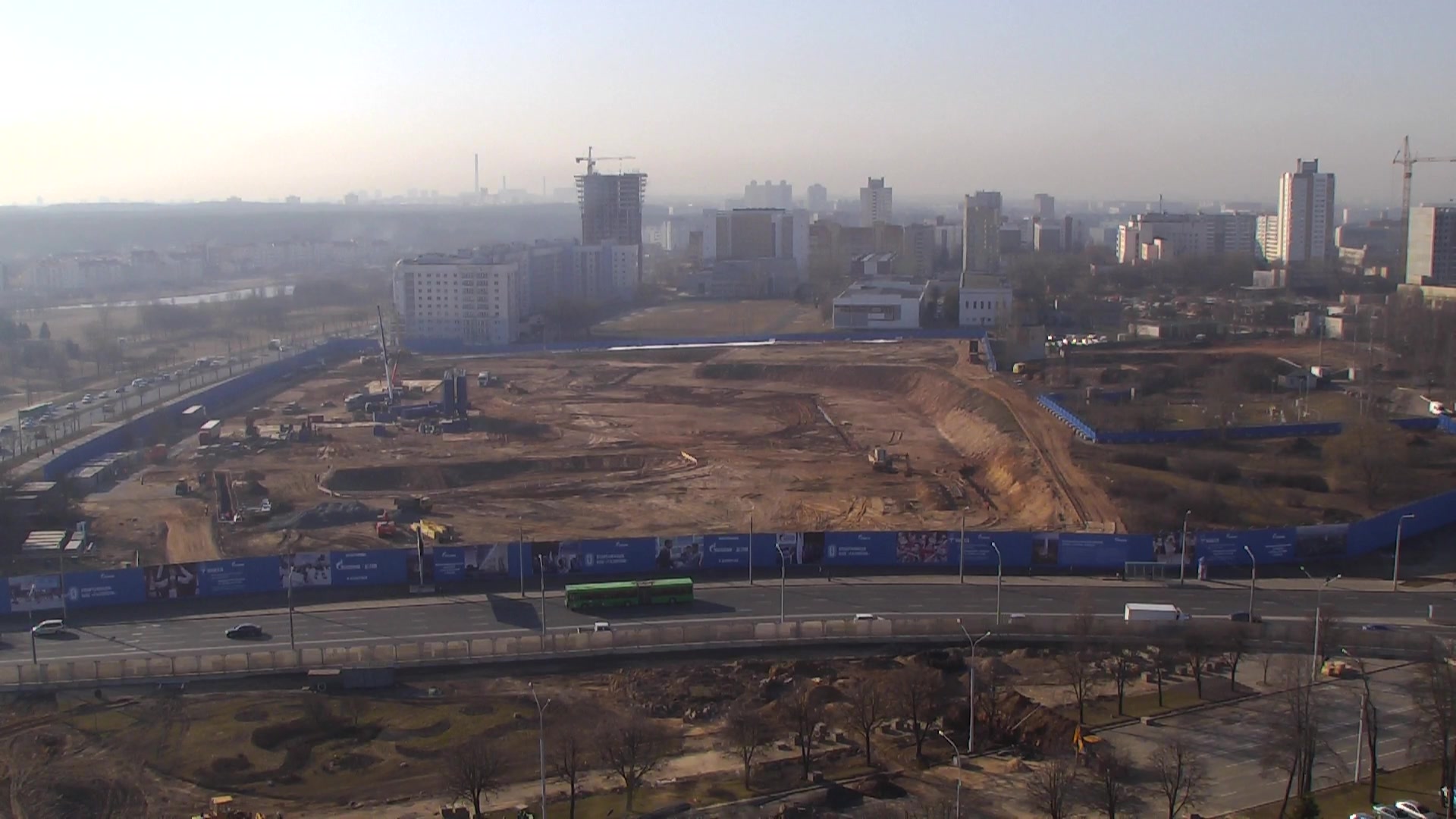

                                    19 March 2015 Diaphragm wall Construction of guide wall for the slurry.


-



                                    25 March 2015 Diaphragm wall Construction of guide wall for the slurry on site.


-

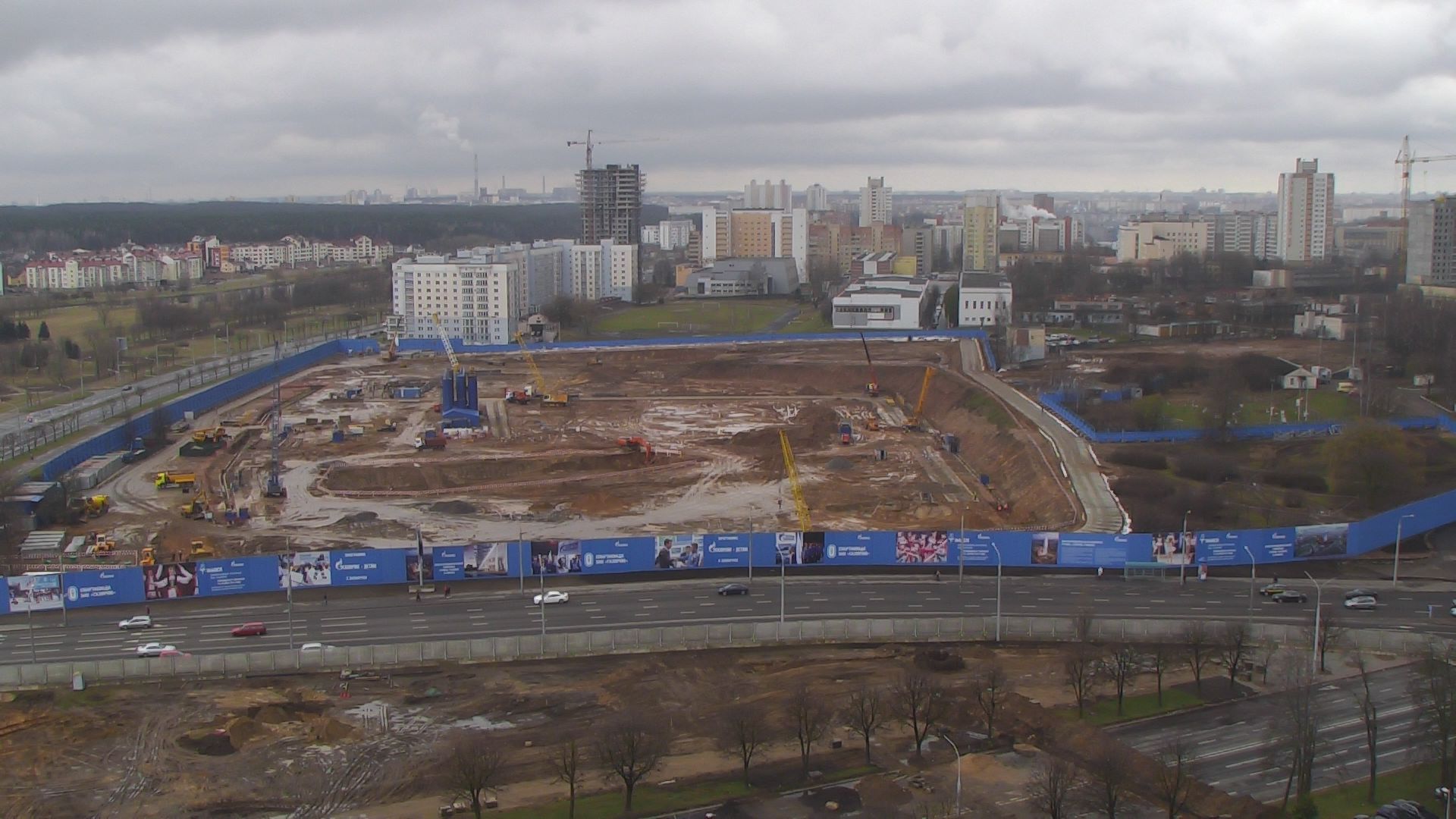

                                    4 April 2015 Diaphragm wall Diaphragm wall first panel construction.


-

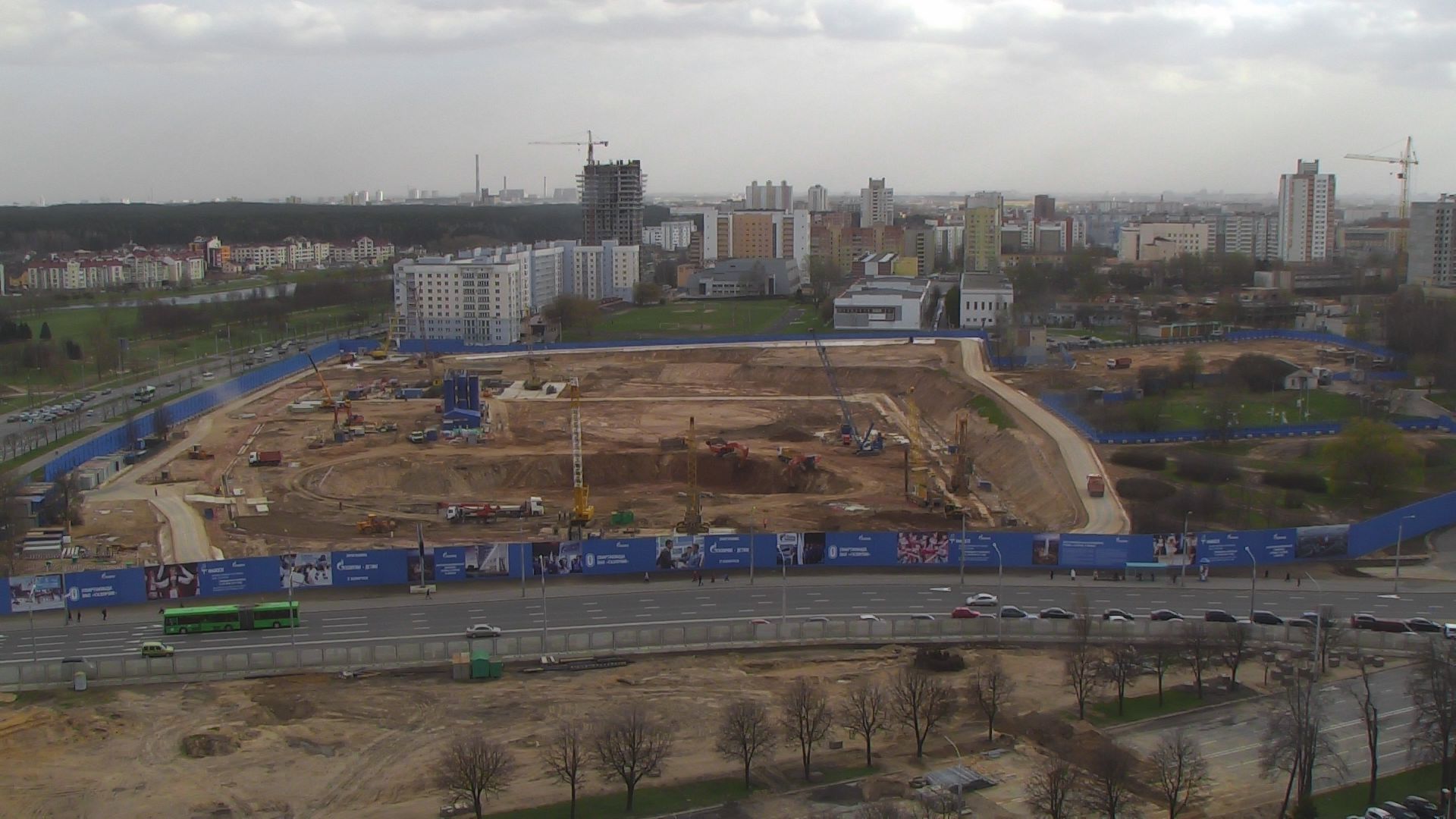

                                    23 April 2015 Diaphragm wall Construction of guide wall for the slurry on the site.


-



                                    30 April 2015 Diaphragm wall Diaphragm wall first panel construction.


-

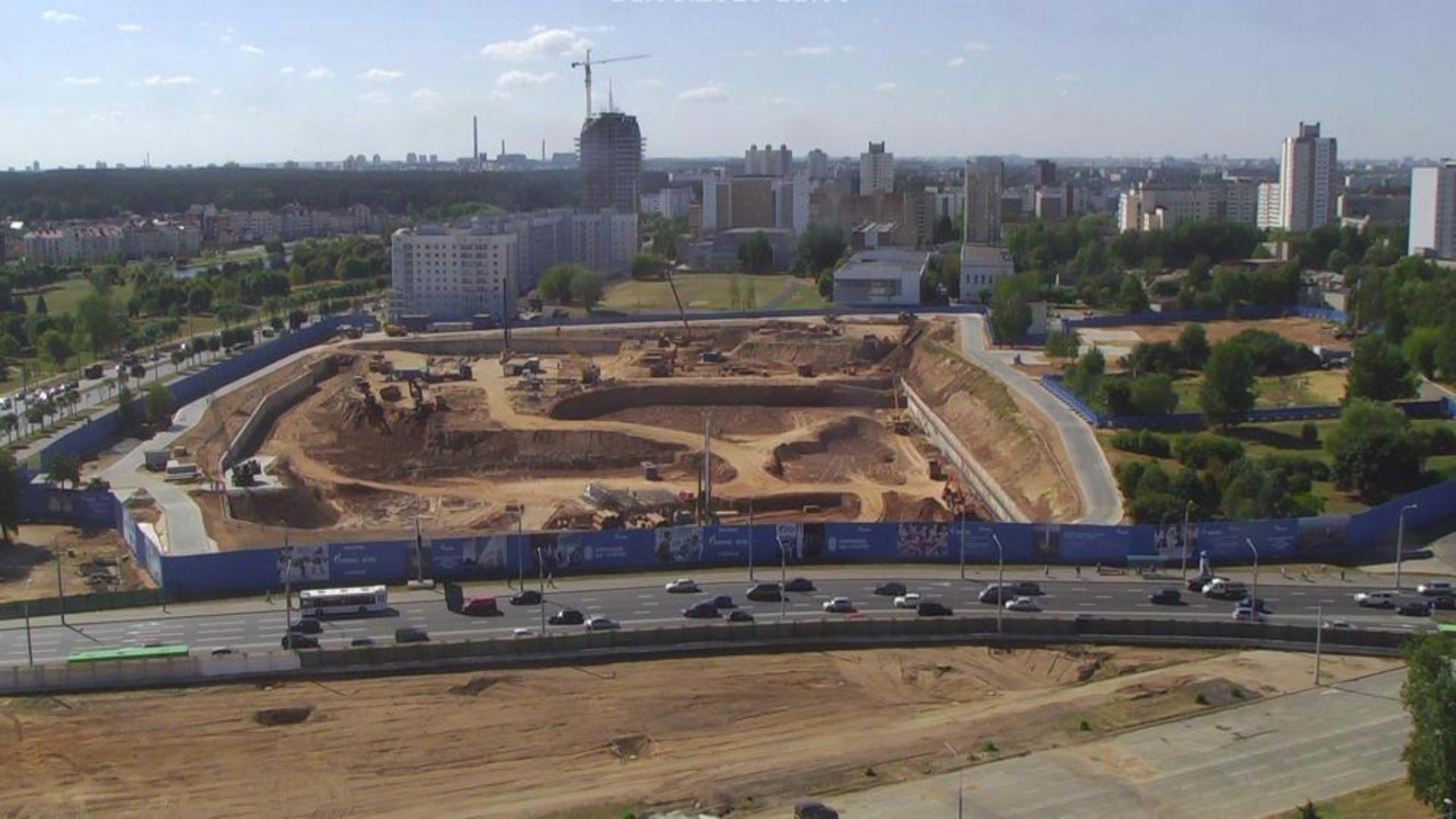

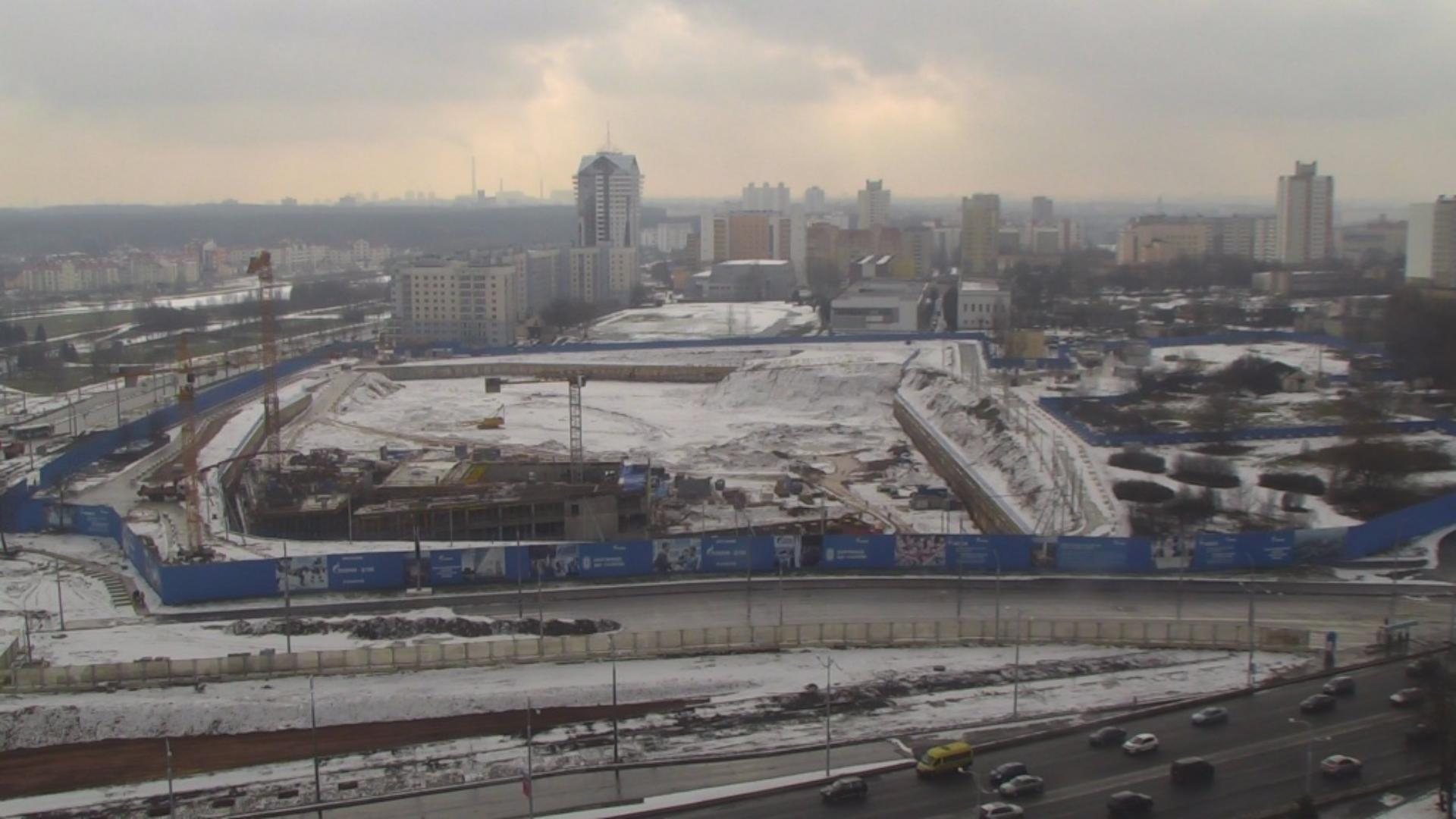

                                    14 August 2015 Main phase of construction Excavation works, pilot piles tested and installed.


-

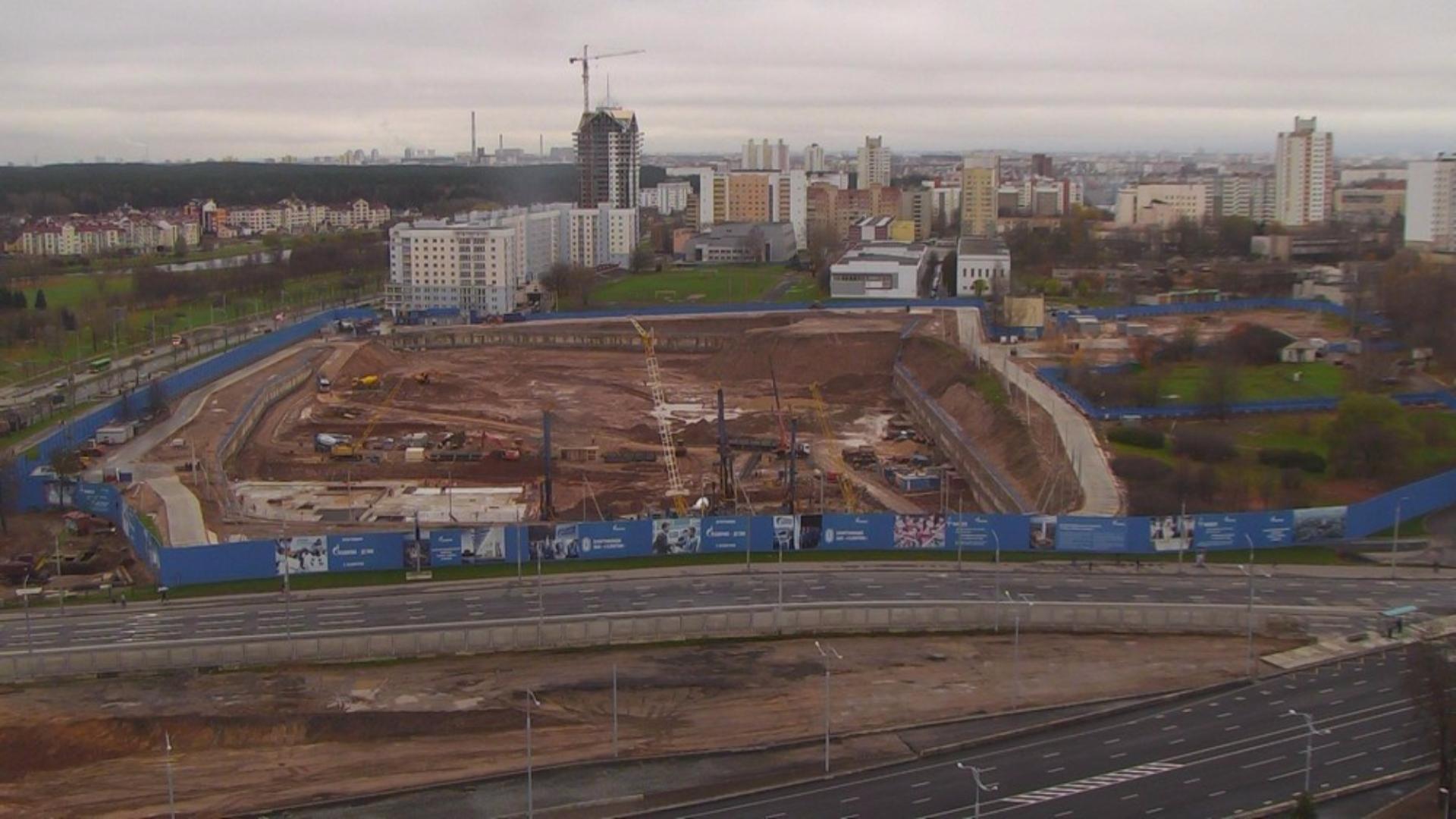

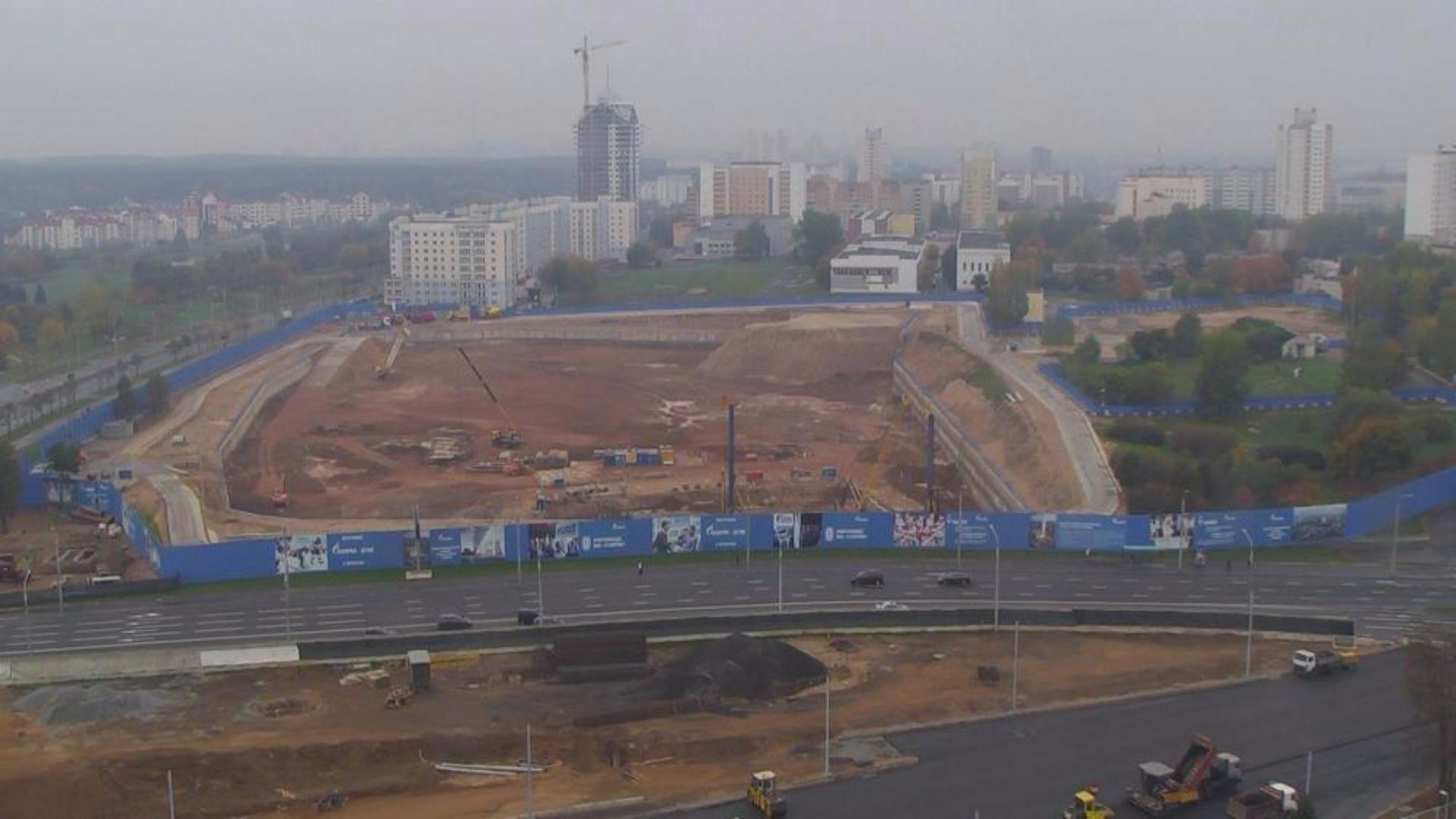

                                    18 October 2015 Main phase of construction Pile work for high-rise building.


-

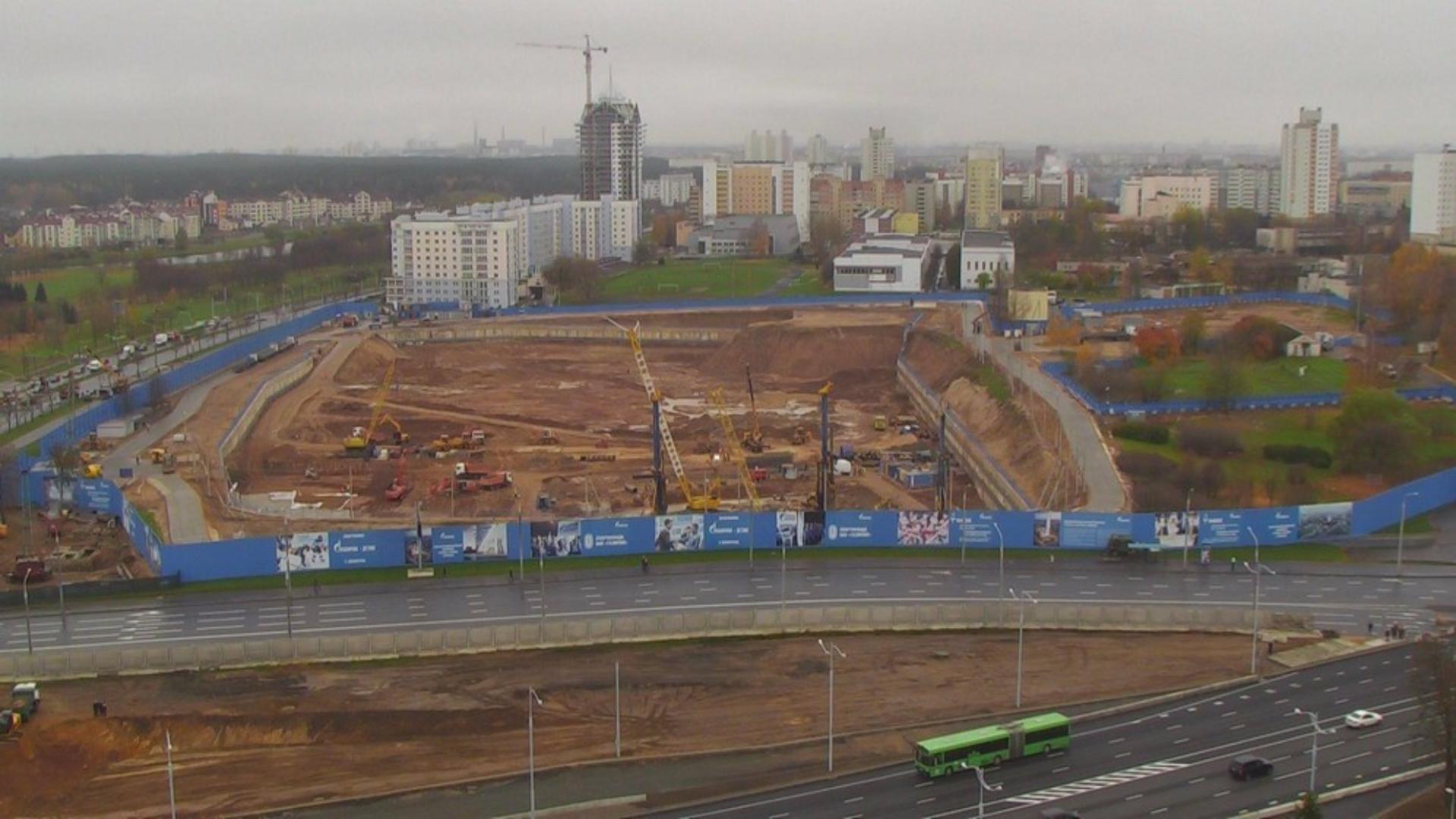

                                    5 November 2015 Main phase of construction Start of hotel and conference-centre construction. Preliminary base compaction and concrete blinding.


-



                                    9 November 2015 Main phase of construction Formwork of hotel base slab underway.


-

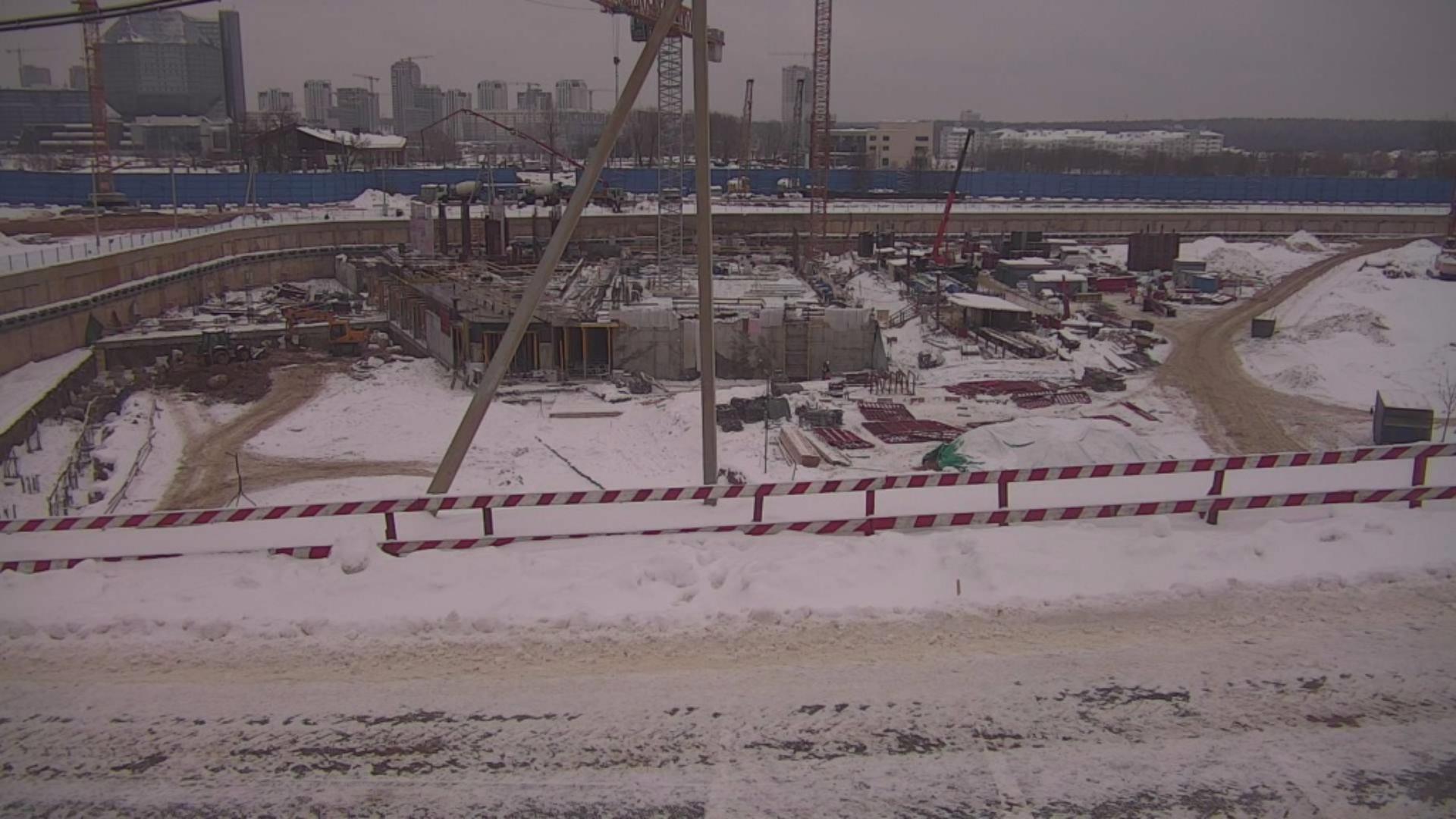

                                    29 December 2015 Main phase of construction Works underway to lay the foundation and substructure of hotel and conference centre.


-



                                    22 January 2016 Main phase of construction Pile cropping and HQ Tower groundwork in progress.


-



                                    26 February 2016 Main phase of construction HQ Tower pilework nearing completion; hotel and conference centre foundation works underway (2 underground floors).


-

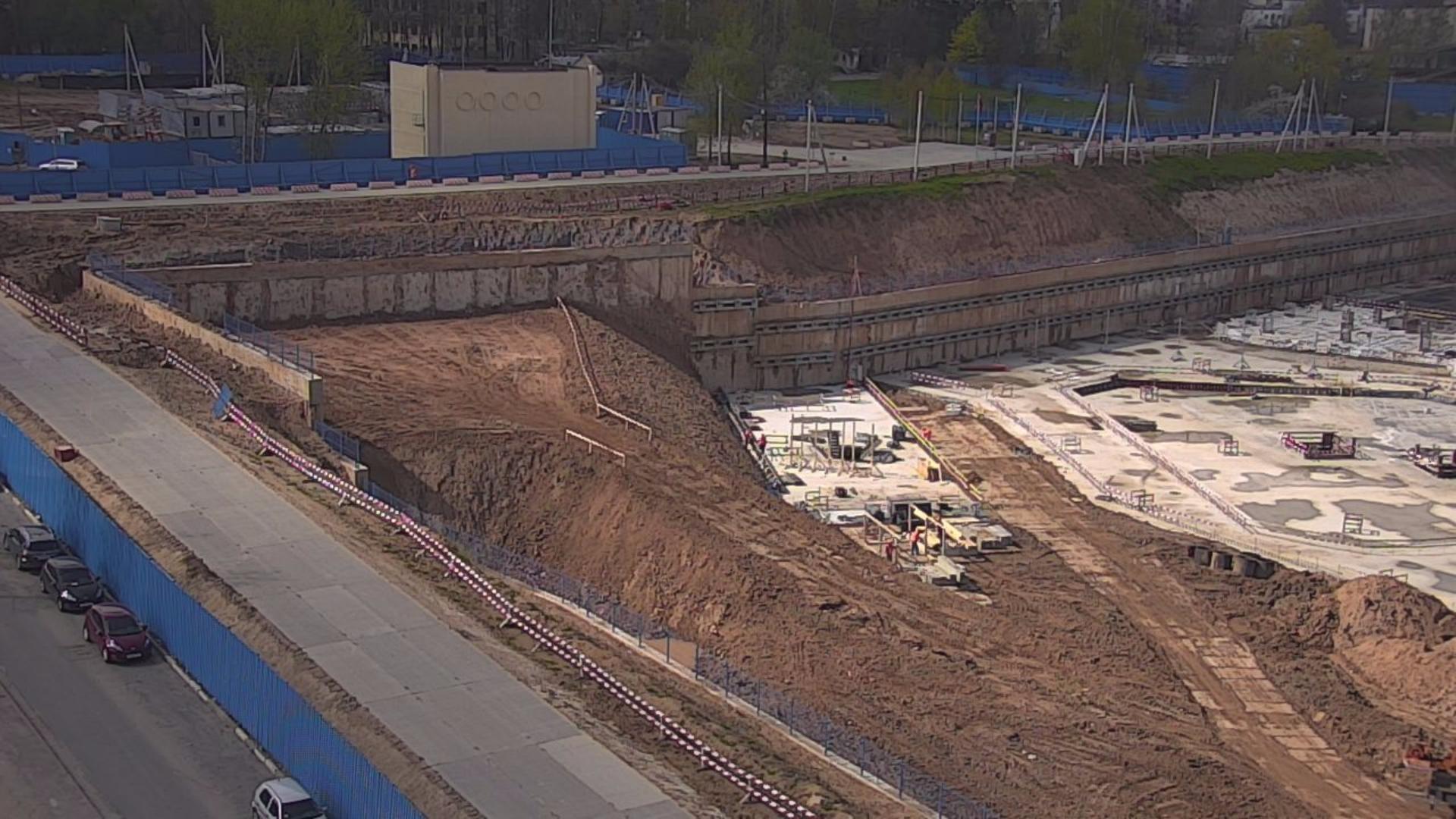

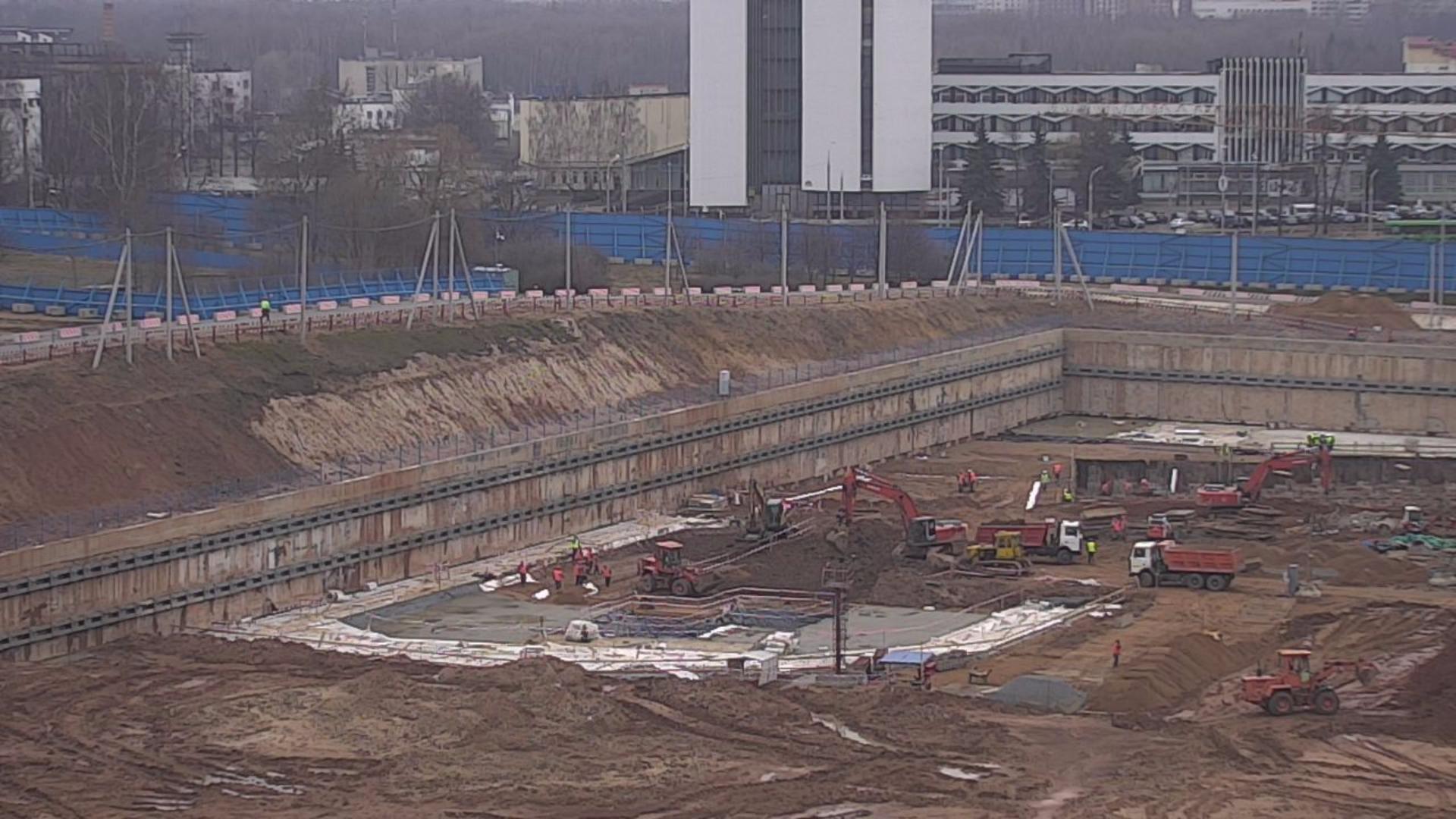

                                    23 March 2016 Main phase of construction Start of ground slab construction (office building №6). Excavation works underway for power plant ground slab (back of house).


-

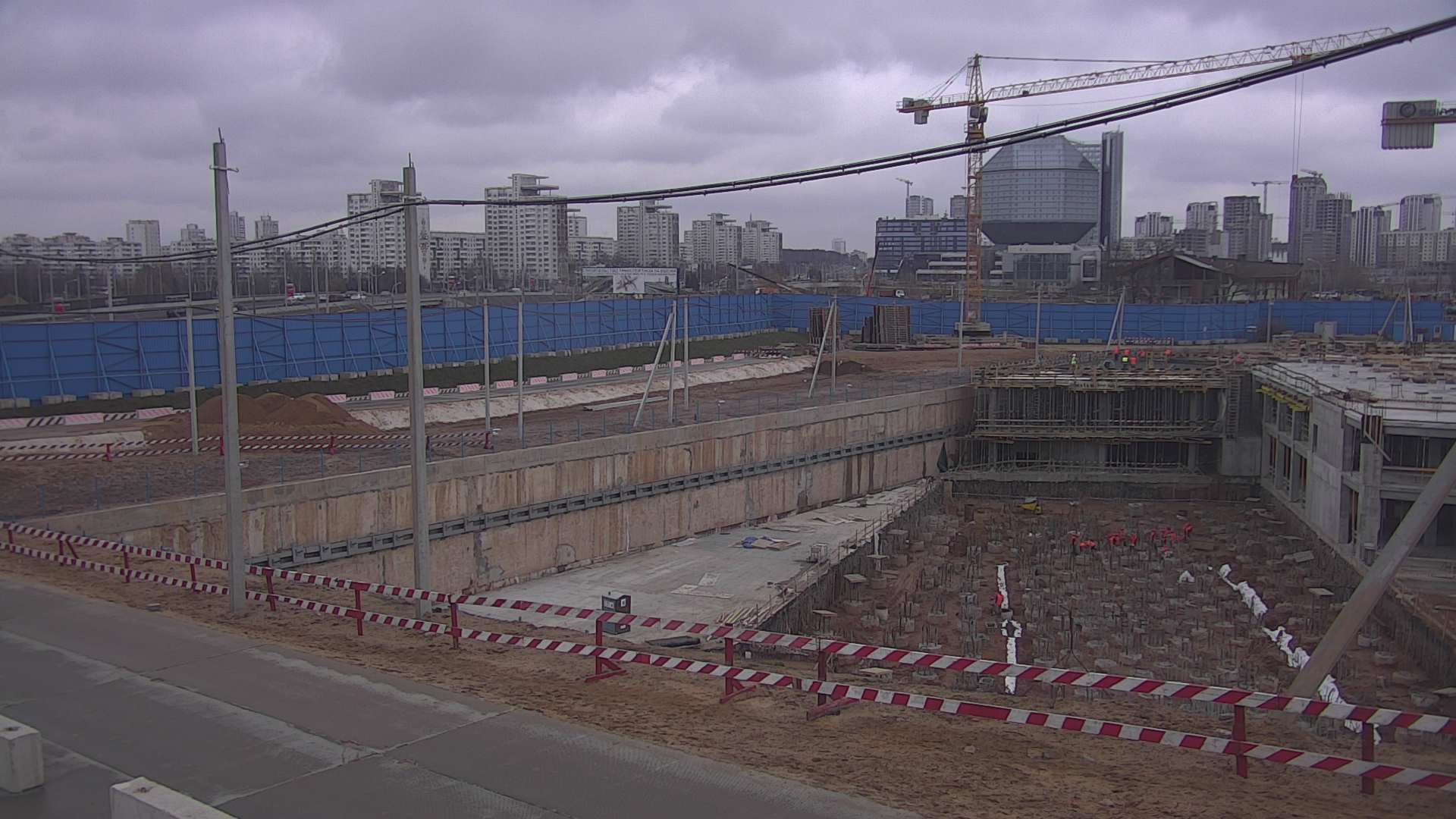

                                    28 March 2016 Main phase of construction HQ Tower pilework complete, start of HQ Tower base concrete construction. Ground slab construction for HQ Tower podium in progress.


-

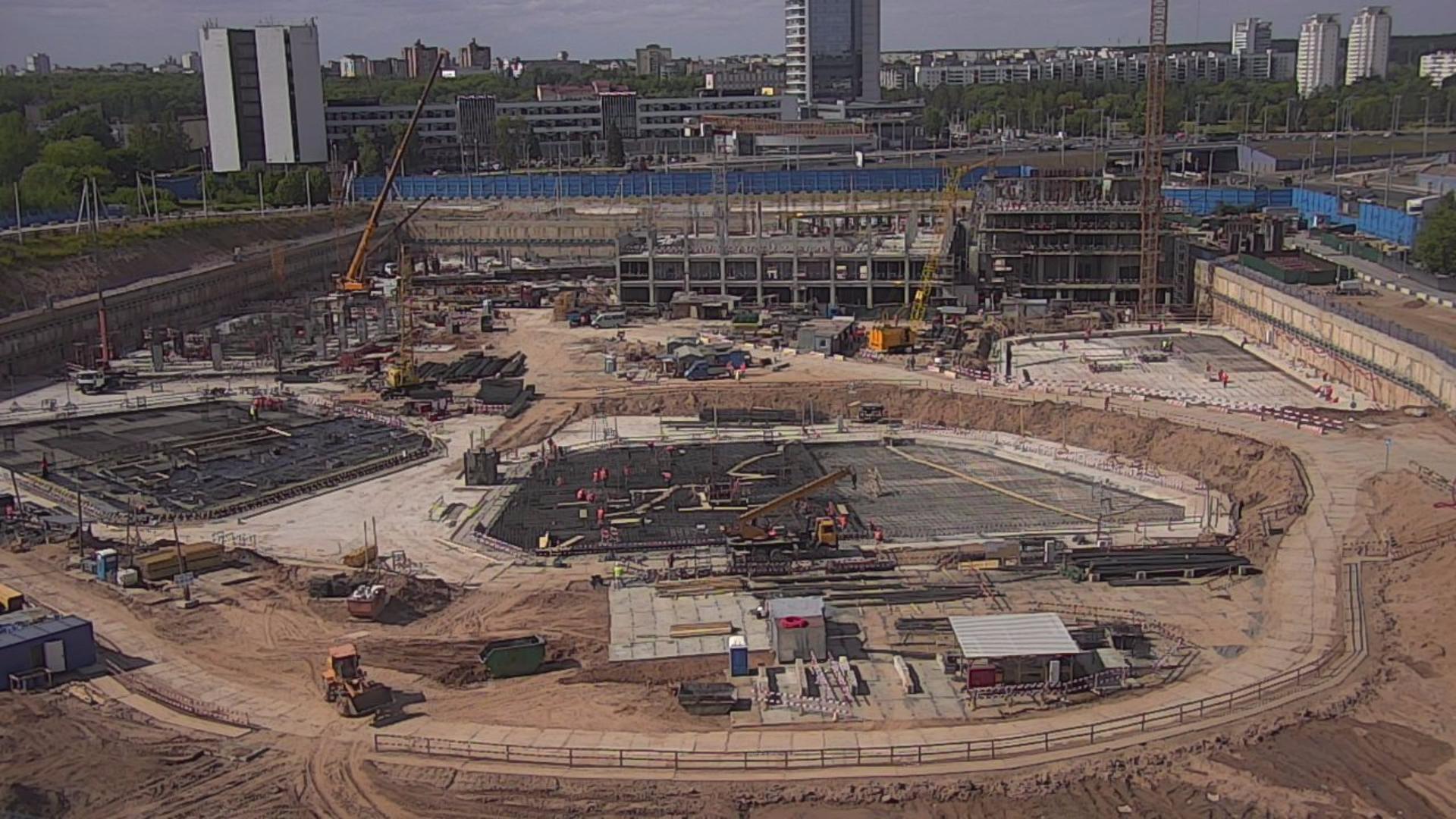

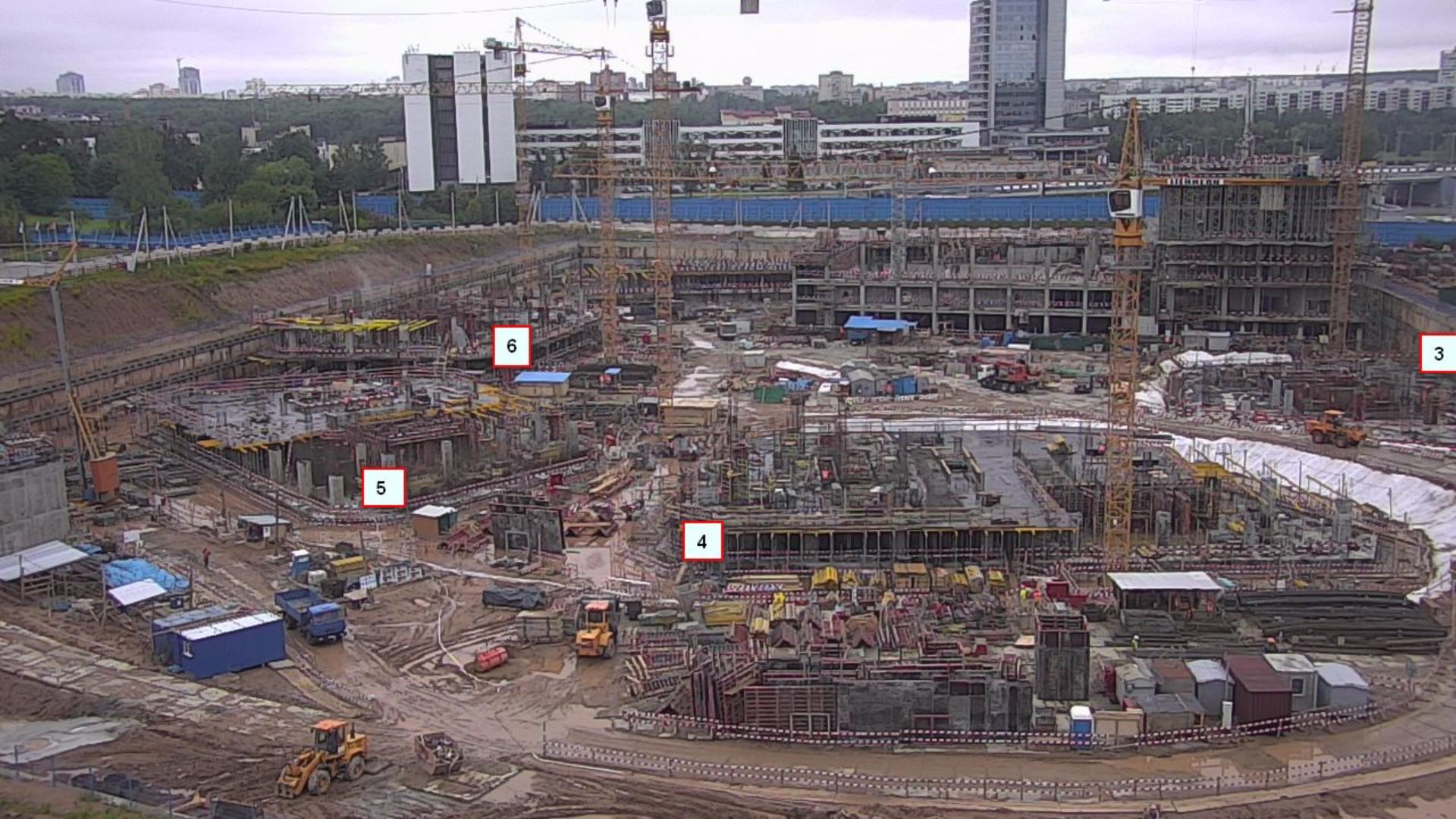

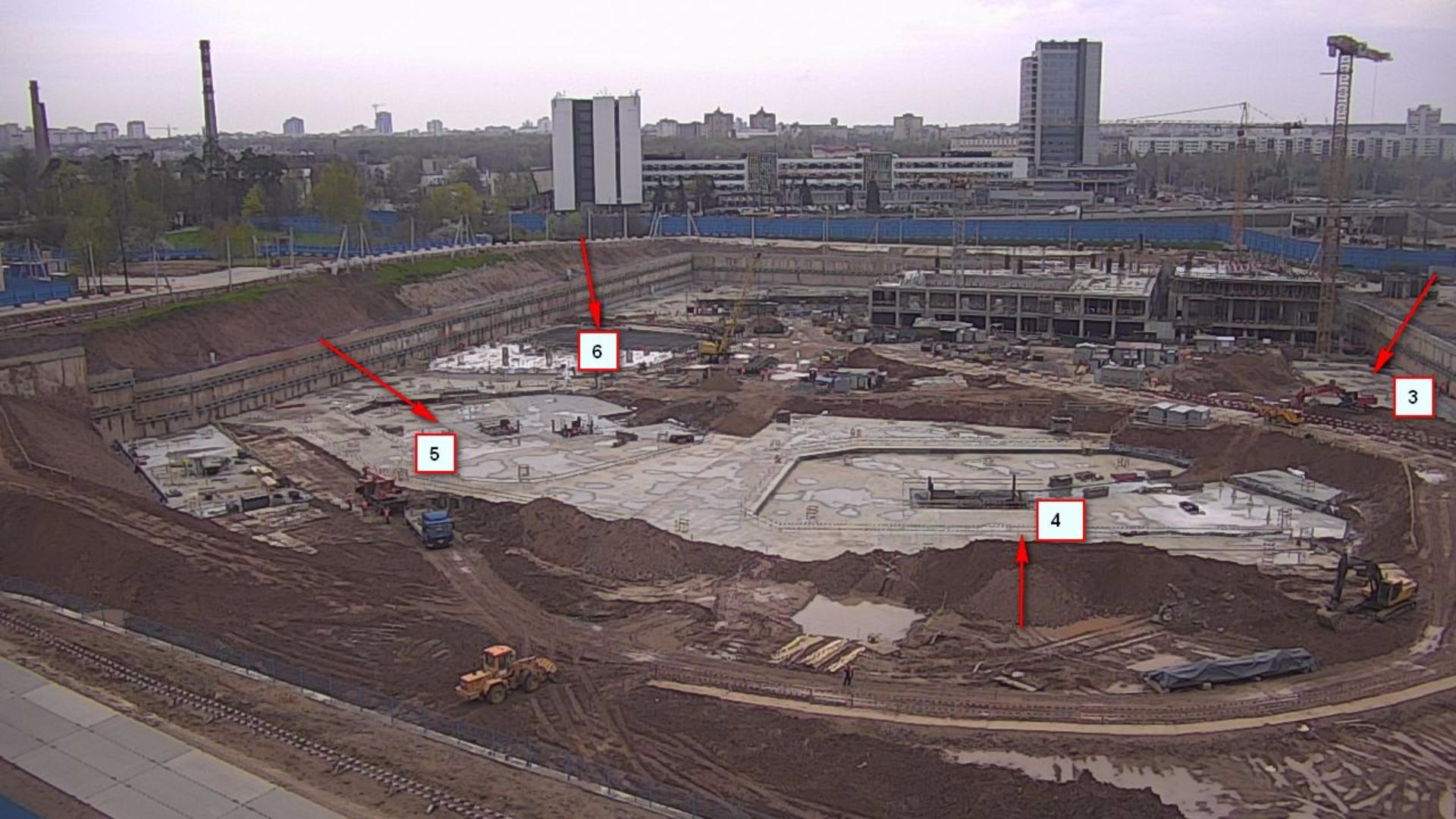

                                            3 May 2016 Main phase of construction Ground slab pouring (buildings 3, 4, 5, 6).




                                            3 May 2016 Main phase of construction Work on power plant ground slab in progress.




                                            3 May 2016 Main phase of construction Construction of hotel and conference centre superstructure in progress.



-



                                    24 May 2016 Main phase of construction  Main phase of construction - Ground slab for power plant administrative and amenity building complete.


-

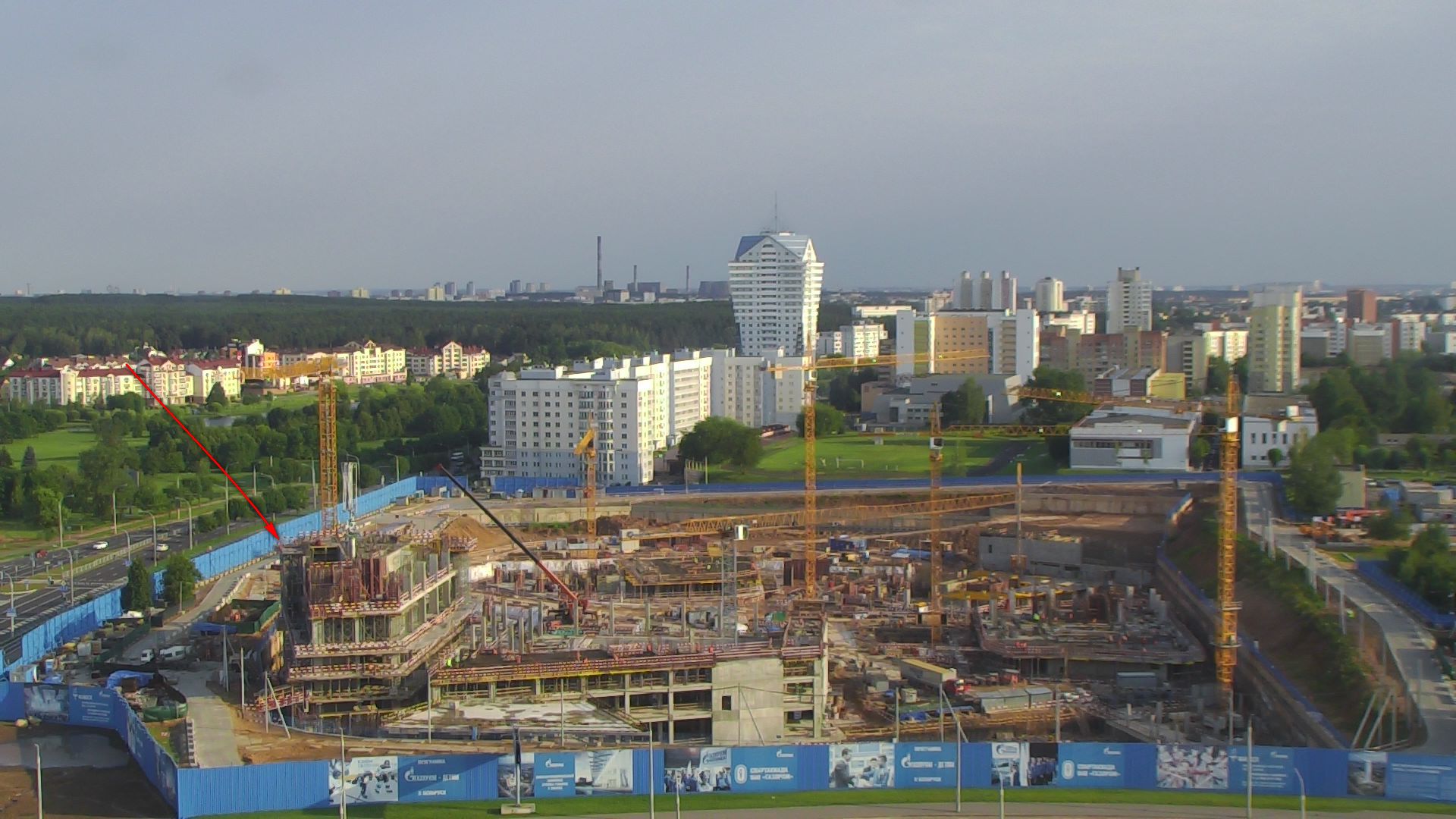

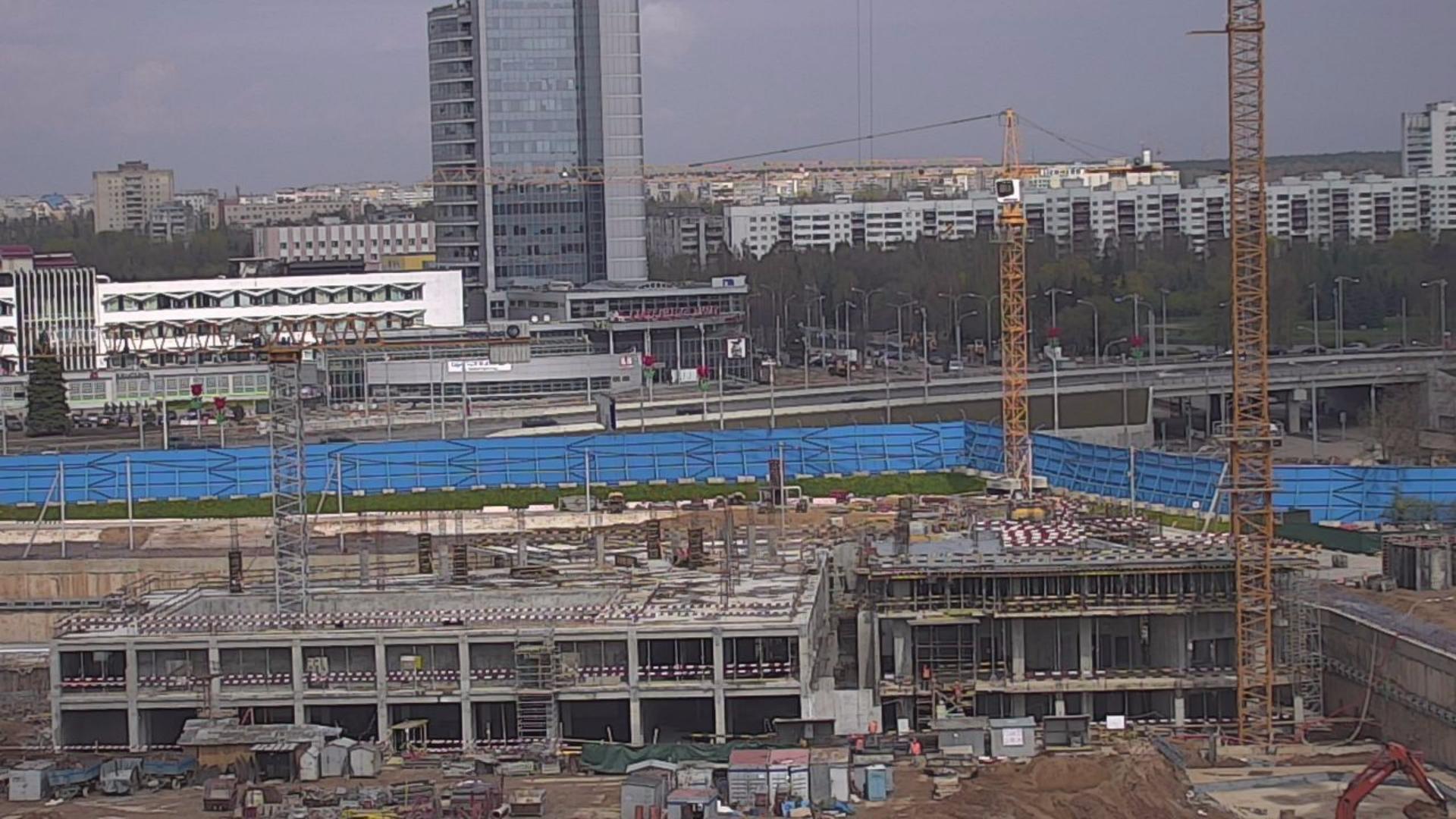

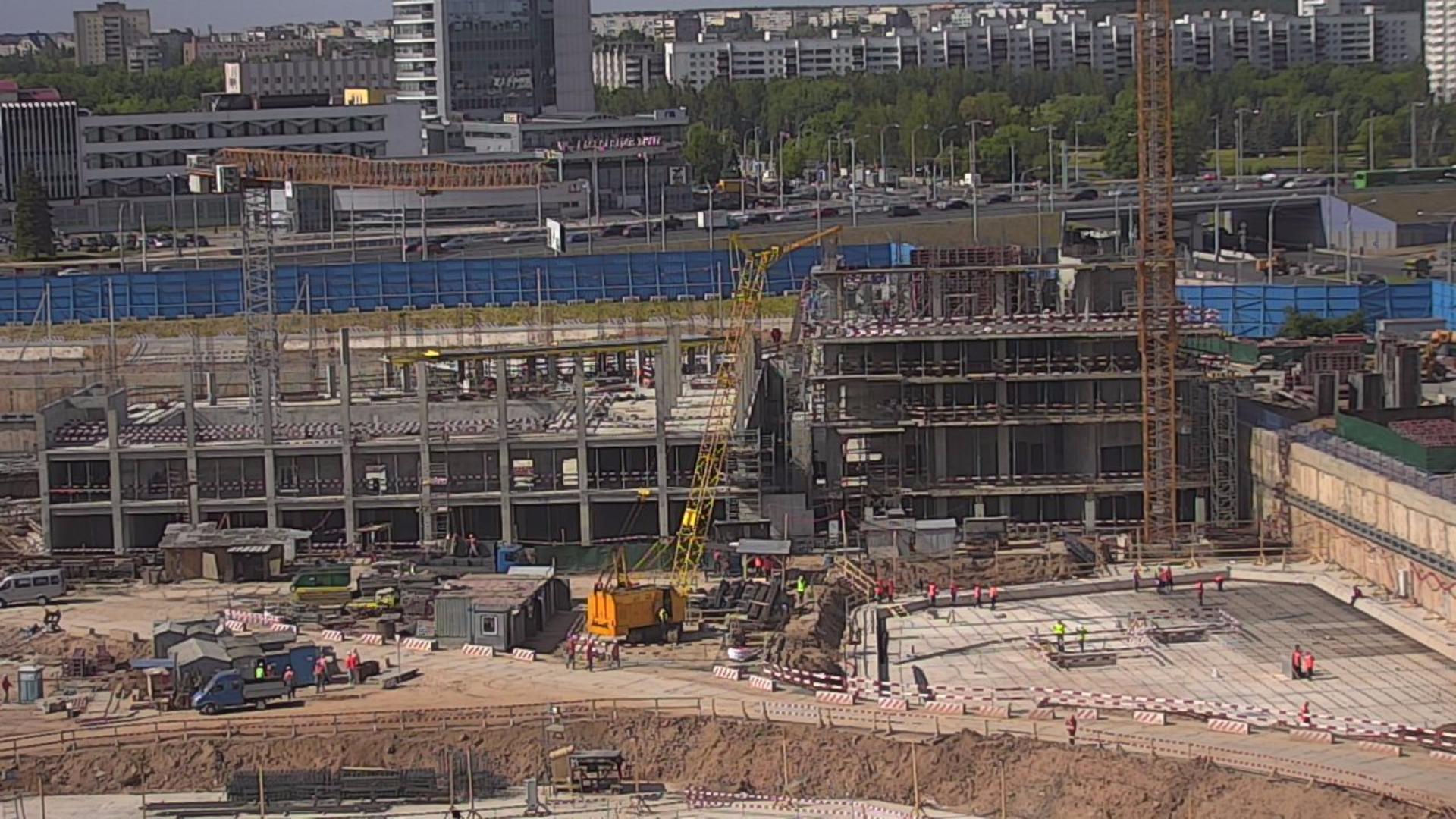

                                    10 June 2016 Main phase of construction Hotel concrete frame construction (level 3, above ground).


-



                                    13 June 2016 Main phase of construction Ground slab reinforcement (commercial buildings 3, 4, 5).


-

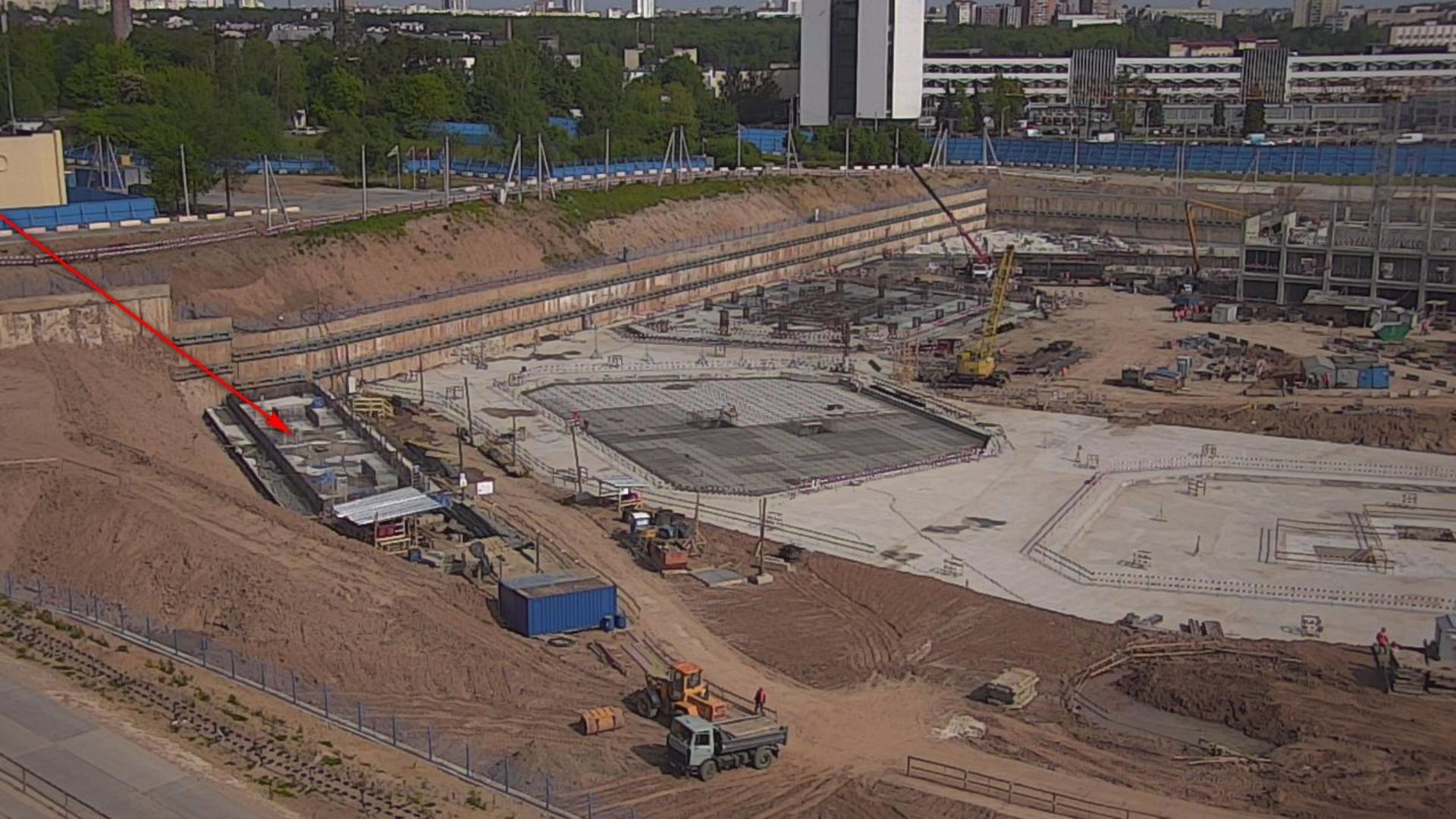

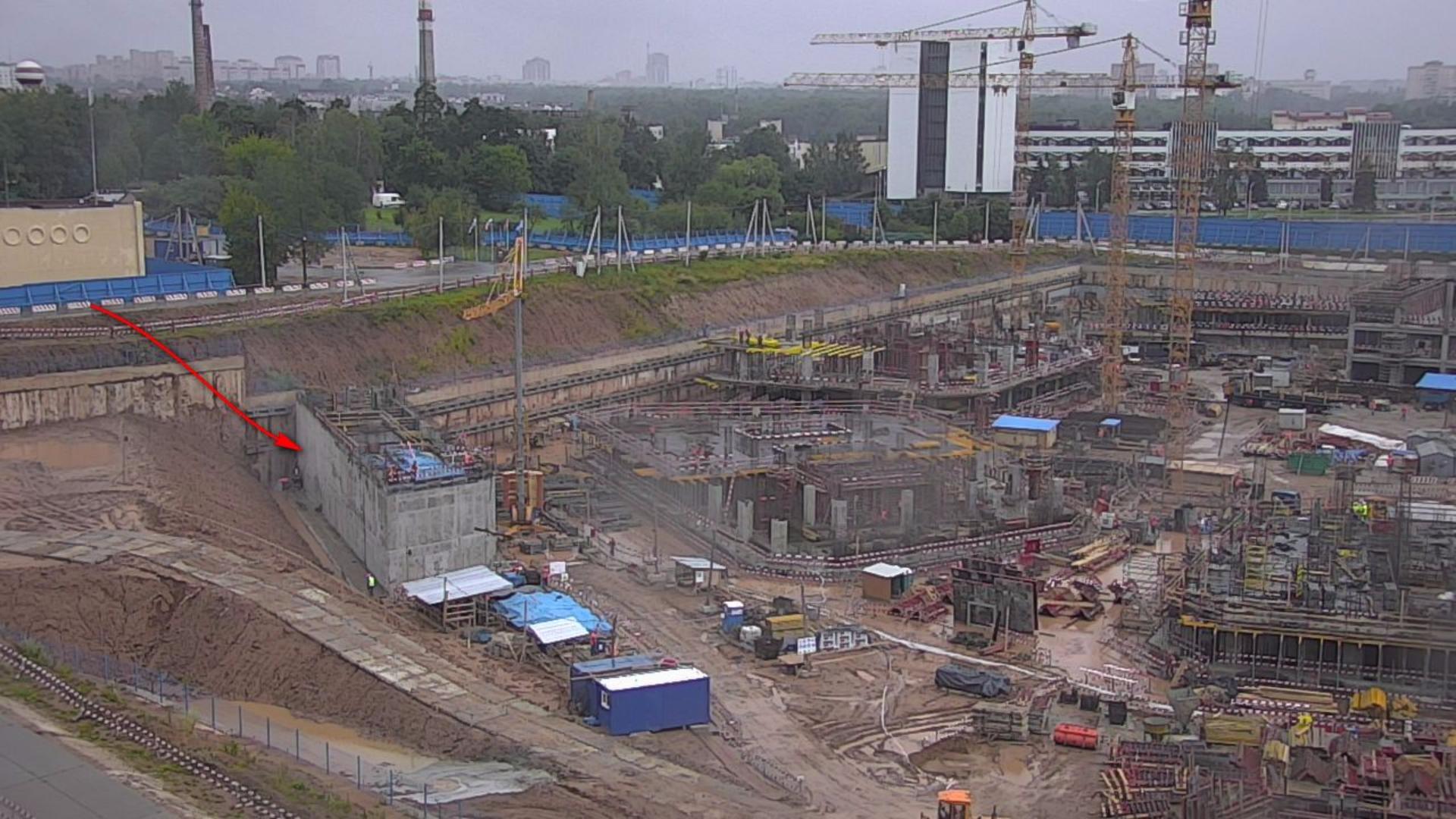

                                    15 July 2016 Main phase of construction In-situ concrete being poured for power plant administrative and amenity building (underground level).


-




                                            18 July 2016 Main phase of construction In-situ concrete being poured for commercial buildings № 3, 4, 5, 6 (underground level).




                                            18 July 2016 Main phase of construction Hotel concrete frame construction underway (level 4, above ground).



-

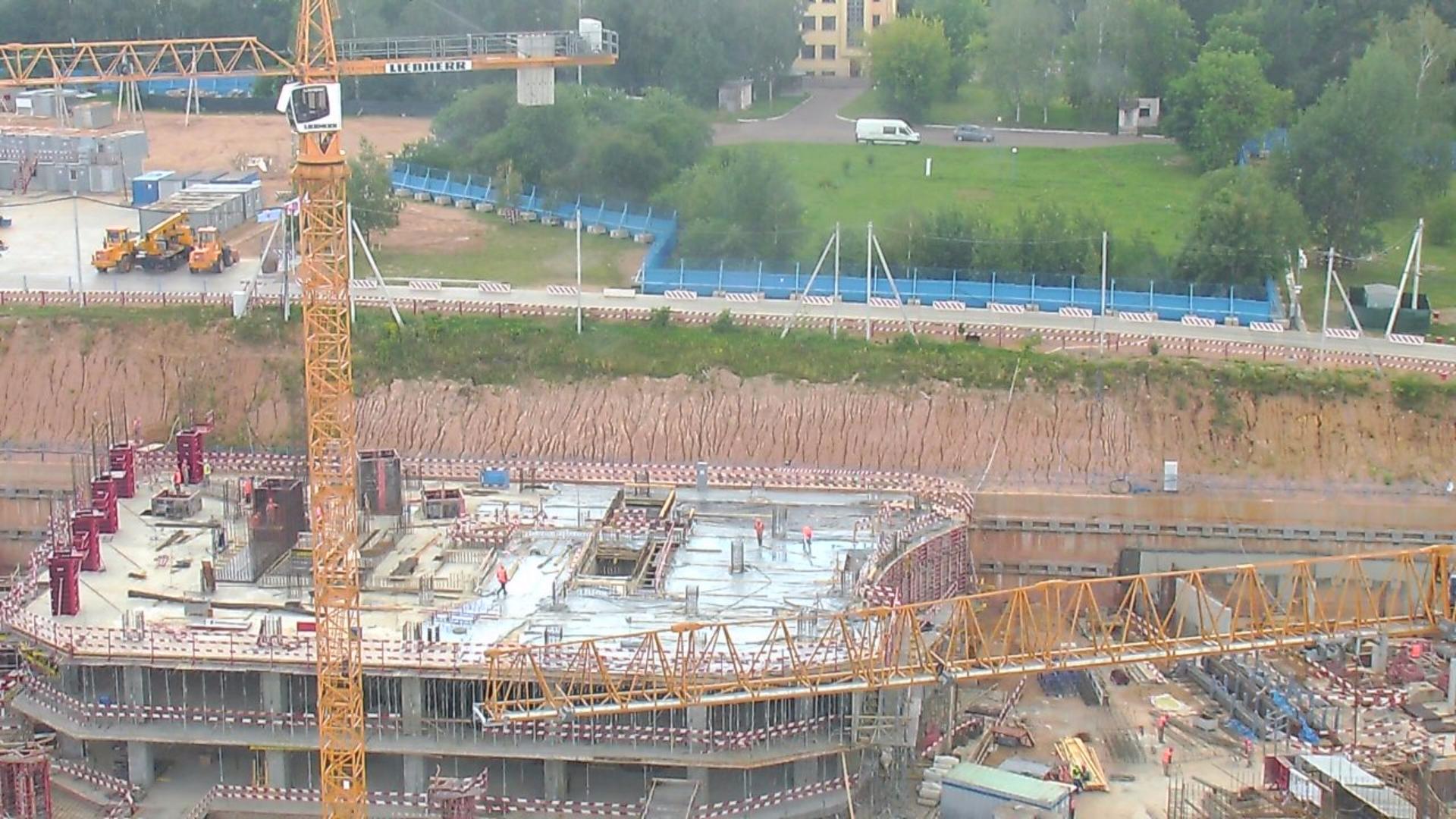

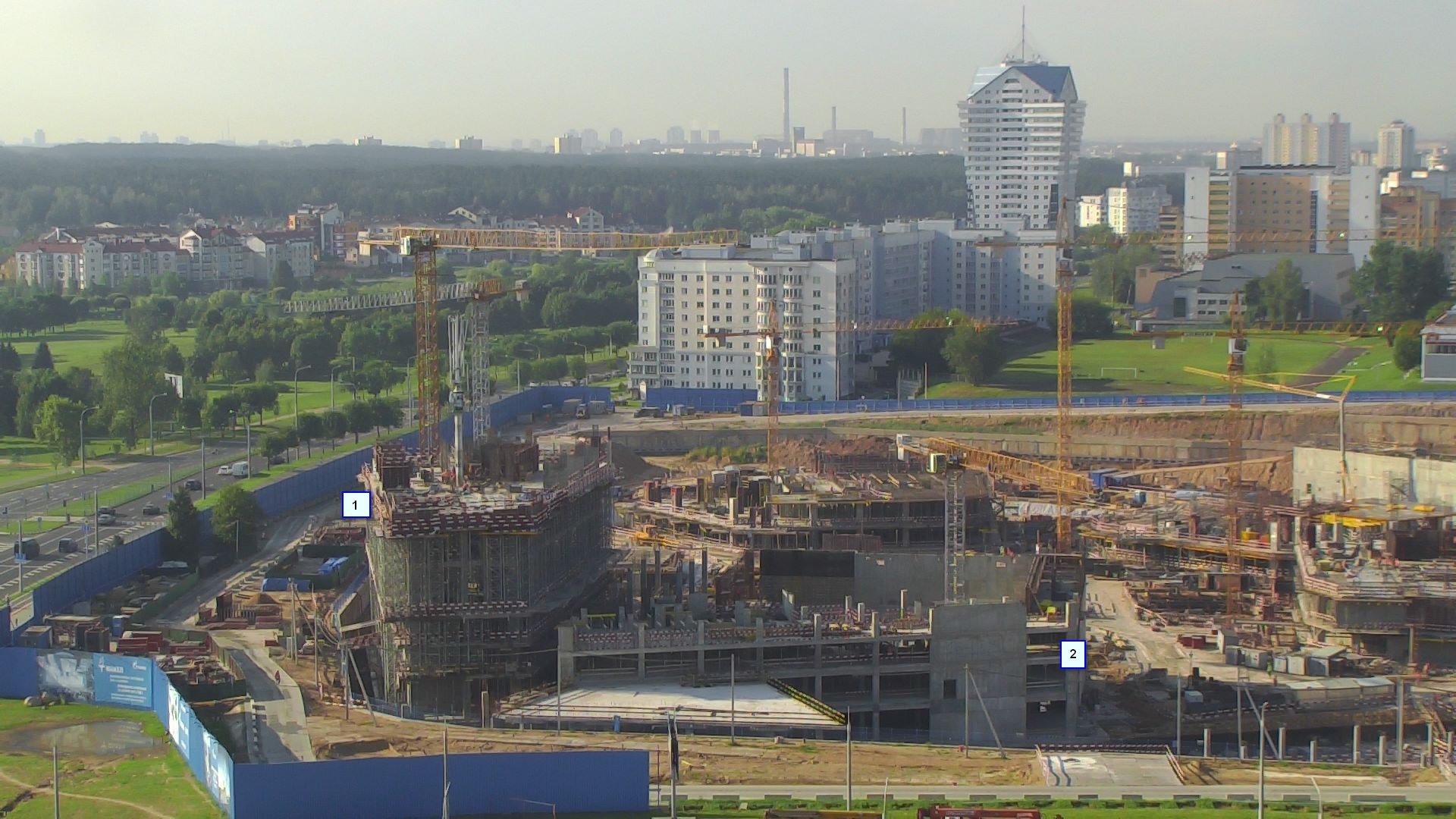

                                    4 August 2016 Main phase of construction In-situ concrete poured on level 5 of hotel (1) and level 1 of conference - center (2).


-



                                    5 August 2016 Main phase of construction In-situ concrete being poured on underground level of commercial building №5 (pic. 2) and level 1 of power plant administrative and amenity building, concrete bedding for ground slab in progress (pic.1).
